Community Hub

Thomas's
Kensington

Welcome to our dedicated project website for the
consolidation of Thomas’s Kensington’s into 1 St Albans Grove.

Please sign-up here if you would like to be updated with news of the project’s progress!

By signing up to the project updates you are consenting to giving us your contact information and be in receipt of our news emails or letters. Your details will be kept on file until the end of the project, will be GDPR protected, and not passed on to any third parties. You can opt-out of the updates at any time.

News, Updates and Timeline

✓  19th May 2023
Planning Permission Approved
✓  19th May 2023
✓  7th June 2023
Consultation on Construction Management Plan sent to Victoria Road Area Residents’ Association
✓  7th June 2023
✓  19th June 2023
Appointment of Main Contractor
✓  19th June 2023
✓  19th July 2023 – Between 16:00 & 19:30
Consultation Drop-in Session at:
Thomas’s Kensington, 21 St. Albans Grove, London W8 5BP.
✓  19th July 2023 – Between 16:00 & 19:30
✓  Monday 31st July 2023
Mobilisation and Site Setup
✓  Monday 31st July 2023
✓  September – October 2023
Site Setup and Soft Strip
✓  September – October 2023
✓  November 14th 2023
Planning application, PP/23/06732, validated by RBKC.
✓  November 14th 2023
✓  20th November 2023
Mobilisation of the demolition process and associated enabling works.
✓  20th November 2023
✓  December 2023
Superstructure and Steel Frame
✓  December 2023
✓  Early 2024
Demolition and underpinning works, in addition to the erection of scaffolding.
✓  Early 2024
✓  Early 2024
Continuous noise, dust, and vibration mitigation measures have been put in place and are constantly monitored.
✓  Early 2024

Latest News

Weekly Update – w/c 06 February 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • M&E installation continued to progress in Atlantic House and Lytham House.
  • Lytham House roof slab will be completed 7th Feb.
  • Link Building and North Stair Core superstructure has progressed.
  • North boundary retaining wall is nearing completion.
  • Internal partitions continued within Atlantic House & Lytham House.
  • Atlantic House cladding sheathing board progressed.
  • Façade restoration works progressed on Lytham House.
  • Structural works to new basement sub-station completed.
  • Roof membranes to Atlantic House progressed.
  • Brick façade infills progressed.
  • Waterproofing to basement areas has progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 10/02/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Link Building will continue.
  • Brickwork commencing on the Atlantic House Terrace.
  • Movement, Noise, Vibration and Dust monitoring ongoing.
  • Fit-out works to new basement sub-station will be progressing.
  • M&E installation continues to progress in Atlantic & Lytham House.
  • Internal partitions continue to progress in Atlantic & Lytham House.
  • Window installation to Lytham House will commence.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – February 2025

Continuing from our previous correspondence, we would like to inform you about the works that have taken place during the past month and the upcoming works that will take place in February at 1 St Albans Grove.

WORKS UPDATE FOR JANUARY
  • Lytham House Roof was poured.
  • Roofing commenced on L2 Atlantic House terrace.
  • Crane had continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Steel erection in Link Building continued.
  • Façade works (SFS) continued in Atlantic House.
  • M&E containment & ducting had continued in Atlantic House.
  • Internal partitions commenced in Atlantic House.
  • Pre-cast wall installation commenced to the North of Atlantic House.
UPCOMING WORKS FOR FEBRUARY
  • Window installation in Lytham House will commence from 04/02/25.
  • Pre-cast wall to the North of Atlantic House will continue, with completion due late February.
  • Substation brickwork & waterproofing will commence.
  • Blockwork to the Lift Shaft will be completed.
  • Façade works (SFS) will continue on L2 & the roof of Atlantic House.
  • M&E containment & ducting continued in Atlantic & Lytham House.
  • Insulation & Screed will commence within Atlantic House.
  • Steelwork for external staircase to Lytham House will be completed.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 13th January 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • M&E installation continued to progress in Atlantic House.
  • Lytham House roof steel erection commenced.
  • Intumescent painting of steels continued.
  • Atlantic House cladding sheathing board progressed.
  • Lytham House lift shaft walls progressed.
  • Structural works to new basement sub-station continued.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 13/01/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House and Atlantic House will continue.
  • Stair erection in the east staircore of Atlantic House will be completed.
  • Movement, Noise, Vibration and Dust monitoring ongoing.
  • Façade restoration works will commence.
  • Internal partitions will commence in Atlantic House.
  • Structural works in the Substation will be completed.
  • Bricklayer will commence in the Substation.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – January 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place last month and the upcoming works that will take place next month at 1 St Albans Grove.

WORKS UPDATE FOR DECEMBER
  • Lytham House 2nd & 3rd floors were poured.
  • Atlantic House 3rd floor was poured.
  • Crane had continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Steel erection in Lytham, Atlantic & Link Building continued.
  • Stair installation in the east staircore continued, with 1 flight remaining.
  • Façade works (SFS) commenced in Atlantic House.
  • M&E containment & ducting had continued in Atlantic House.
UPCOMING WORKS FOR JANUARY
  • Lytham House steel frame will continue, with the roof steels being erected w/c 06/01/25.
  • Commencement of the pre-cast wall to the North of Atlantic House.
  • Stair installation in the east staircore will be completed.
  • Waterproofing to Atlantic, Lytham & Substation will commence.
  • Blockwork to the Lift Shaft will continue.
  • Façade works (SFS) will continue on L2 Atlantic House.
  • M&E containment & ducting continued in Atlantic House.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 16th December 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Atlantic House 3rd floor concrete slab was poured.
  • M&E installation continued to progress in Atlantic House.
  • Lytham House 3rd floor steel erection continued.
  • Intumescent painting of steels continued.
  • Atlantic House cladding sheathing board progressed.
  • Lytham House lift shaft walls progressed.
  • Structural works to new basement sub-station continued.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 16/12/24
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House and Atlantic House will continue.
  • Scaffolders on-site, working in both buildings.
  • Stair erection in the east staircore will continue.
  • Concrete pour scheduled for 20/12/24, for Lytham House 3rd floor.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 9th December 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Atlantic House 2nd floor steels completed.
  • M&E installation continued to progress in Atlantic House.
  • Lytham House 2nd floor concrete slab was poured.
  • Intumescent painting of steels continued.
  • Atlantic House cladding sheathing board progressed.
  • Lytham House lift shaft walls progressed.
  • Structural works to new basement sub-station commenced.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 09/12/24
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House and Atlantic House will continue.
  • Atlantic House roof slab will commence.
  • Stair erection in the east staircase will continue.
  • 3rd floor of Atlantic House will be concreted.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – December 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR NOVEMBER
  • Lytham House 1st & 2nd floors were poured.
  • Atlantic House 2nd & 3rd floors were poured.
  • Crane had continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Steel erection in both Lytham & Atlantic continued.
  • Bricklayers continued the façade infill works & continued building the staircase in Atlantic House.
  • Façade works (SFS) commenced in Atlantic House.
  • M&E containment & ducting had started in Atlantic House.
UPCOMING WORKS FOR DECEMBER
  • Lytham House steel frame will continue, with the 3rd floor being poured.
  • Stair installation in the east staircase will commence.
  • 3rd floor of Atlantic House will be poured.
  • Blockwork to the Lift Shaft will continue.
  • Façade works (SFS) will continue.
  • M&E containment & ducting continued in Atlantic House.
  • Façade infill works will continue across both Atlantic & Lytham House.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 2nd December 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Atlantic House 2nd floor steels completed.
  • M&E installation continued to progress in Atlantic House.
  • Lytham House 2nd floor concrete slab was poured.
  • Intumescent painting of steels continued.
  • Atlantic House cladding sheathing board progressed.
  • Lytham House lift shaft walls progressed.
  • Structural works to new basement sub-station commenced.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 02/12/24
  • Forming basement slab in Lytham House.
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House and Atlantic House will continue.
  • Lytham House 2nd floor concrete slab will be poured.
  • Atlantic House roof slab will commence.
  • Installation of the east stairs will commence.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 25th November 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Atlantic House 2nd floor steels continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.

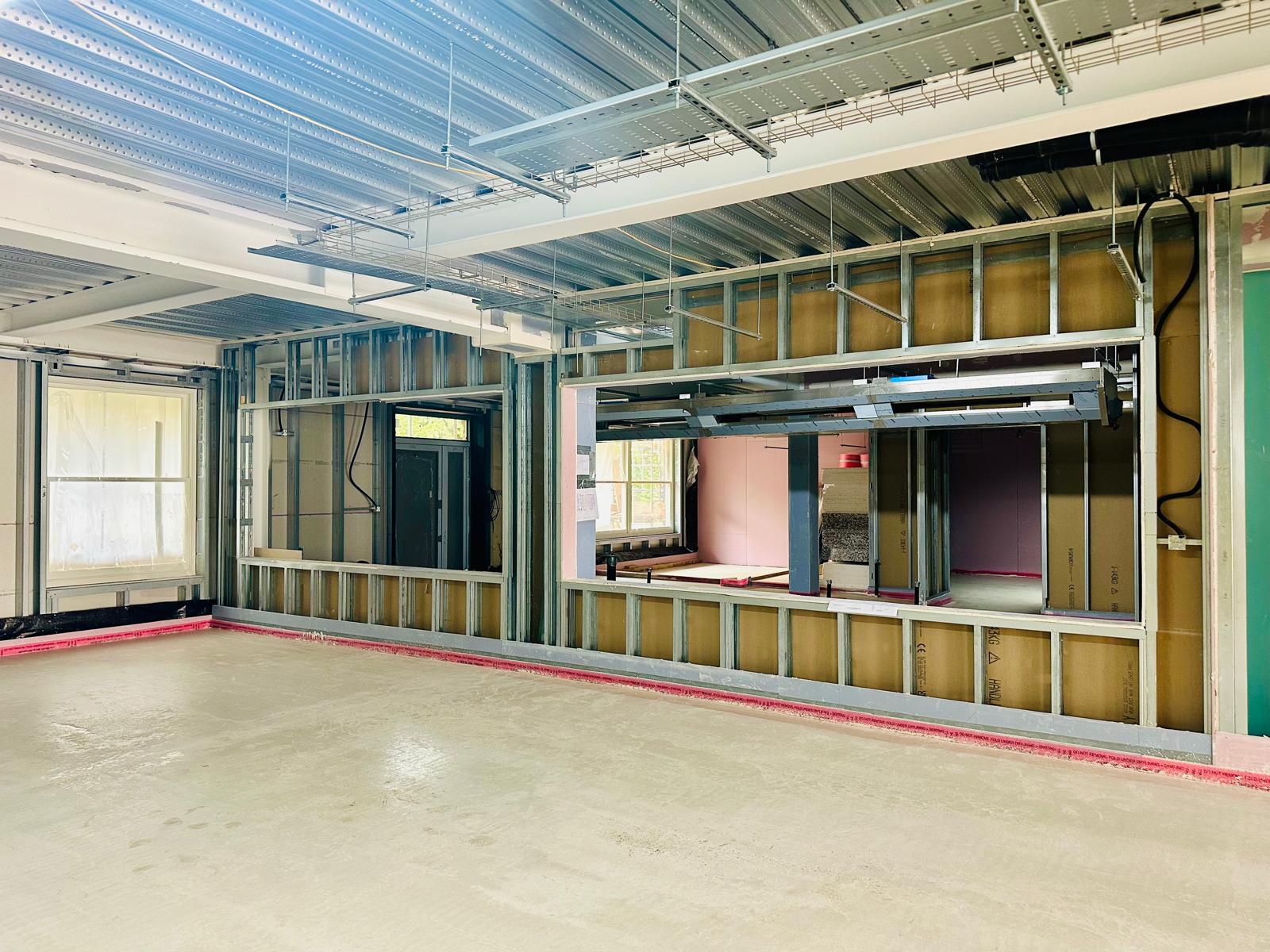

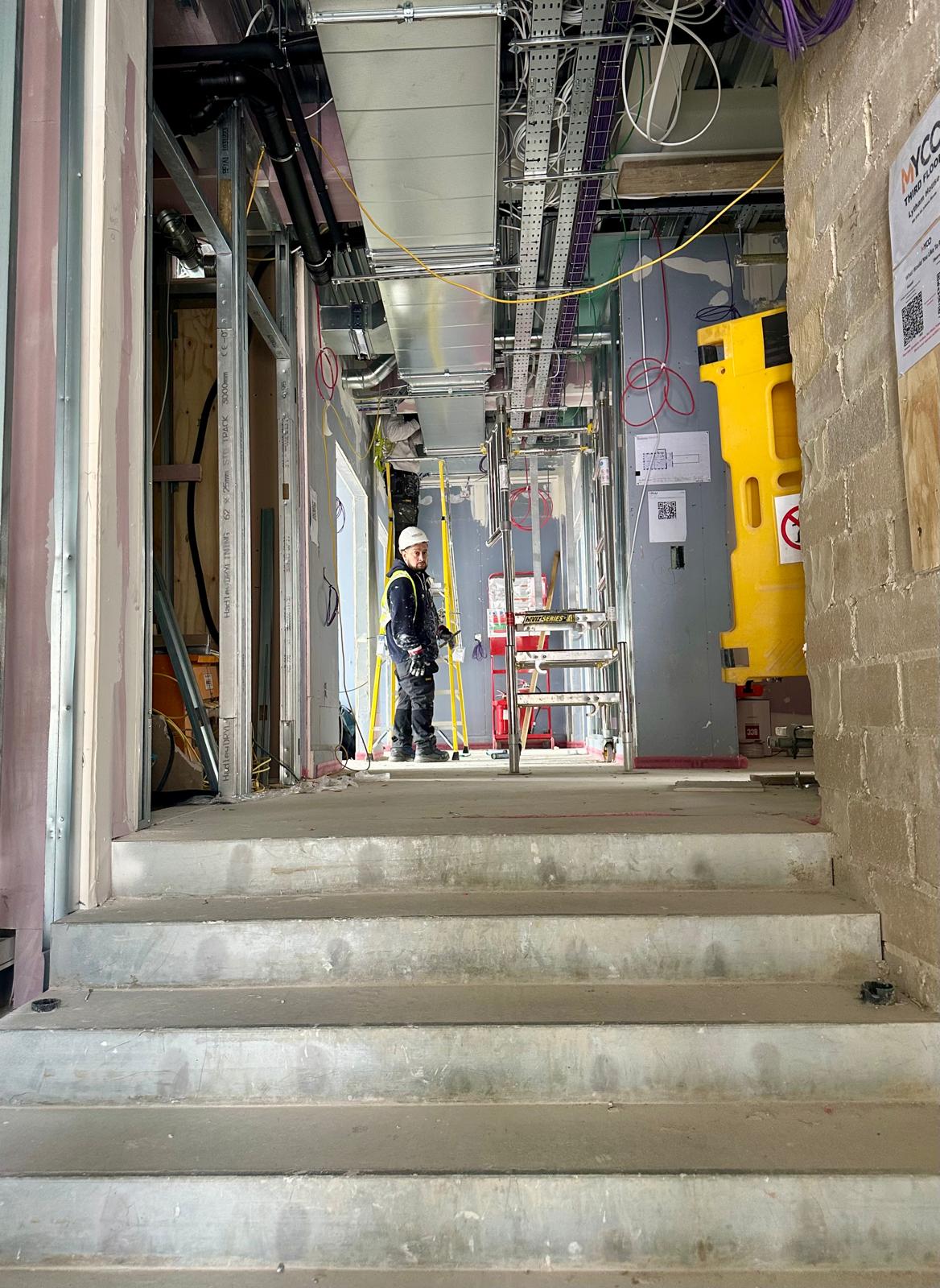

  • M&E installation started on site.
  • Lytham House 1st floor was poured.
  • Intumescent painting of steels continued.
  • SFS (steel formed sections) commenced in Atlantic House. Lytham House basement was poured.

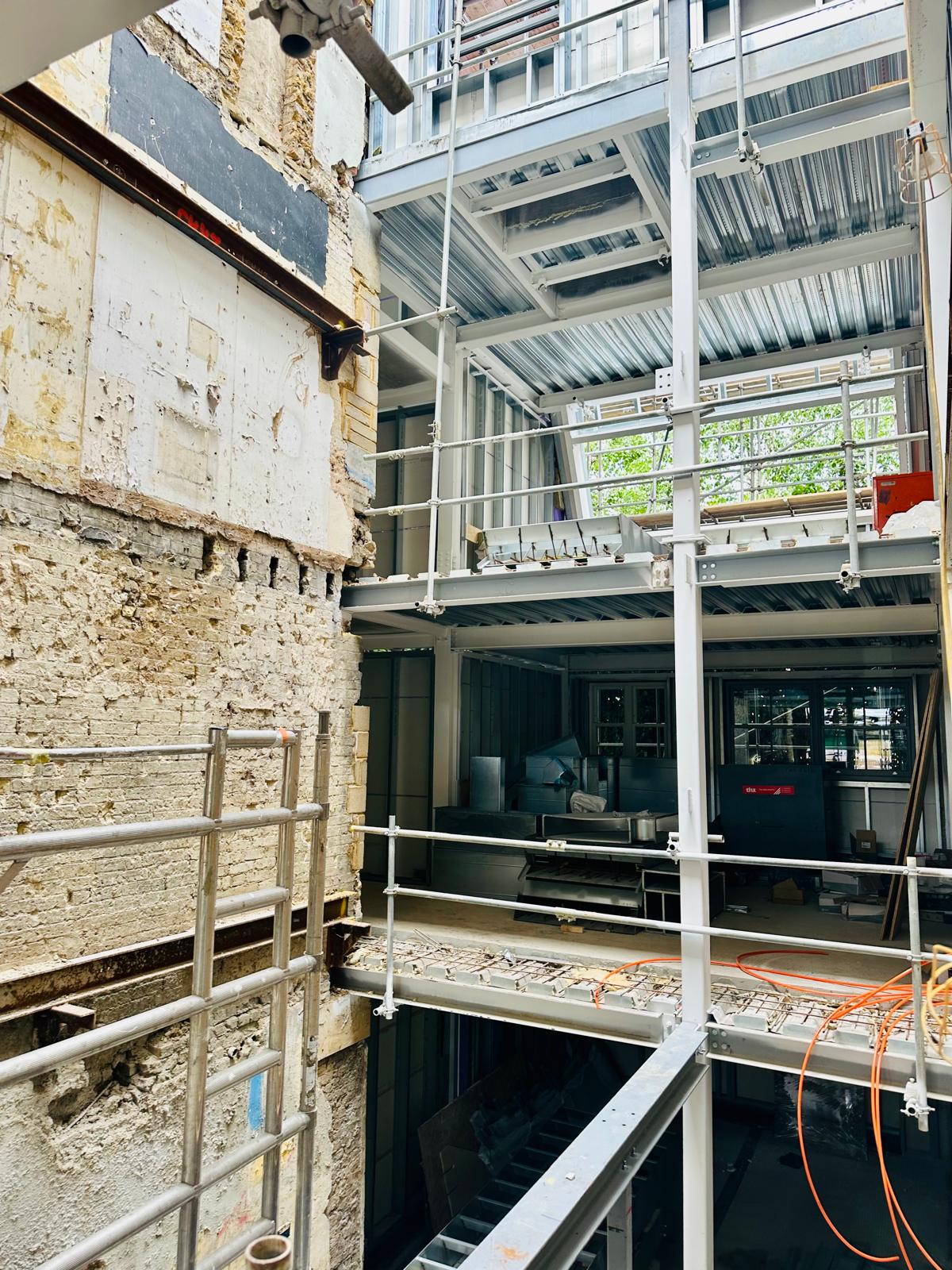

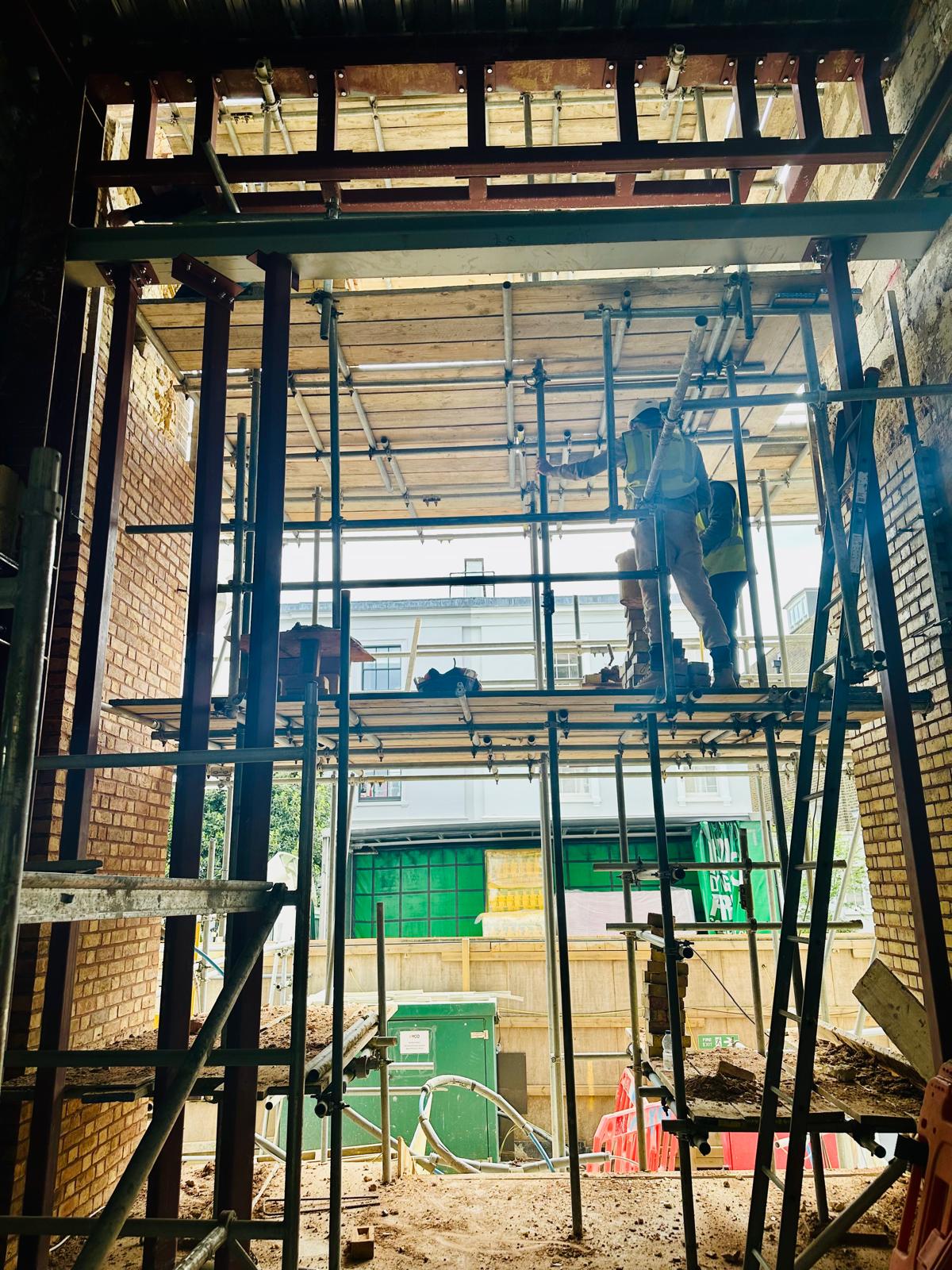

  • Bricklayers started lift shaft walls.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 25/11/24
  • Forming basement slab in Lytham House.
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House will continue.
  • Installation of the east stairs will commence.
  • Movement, Noise, Vibration and Dust monitoring on going.
  • SFS (steel formed sections) will continue in Atlantic House.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 18th November 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

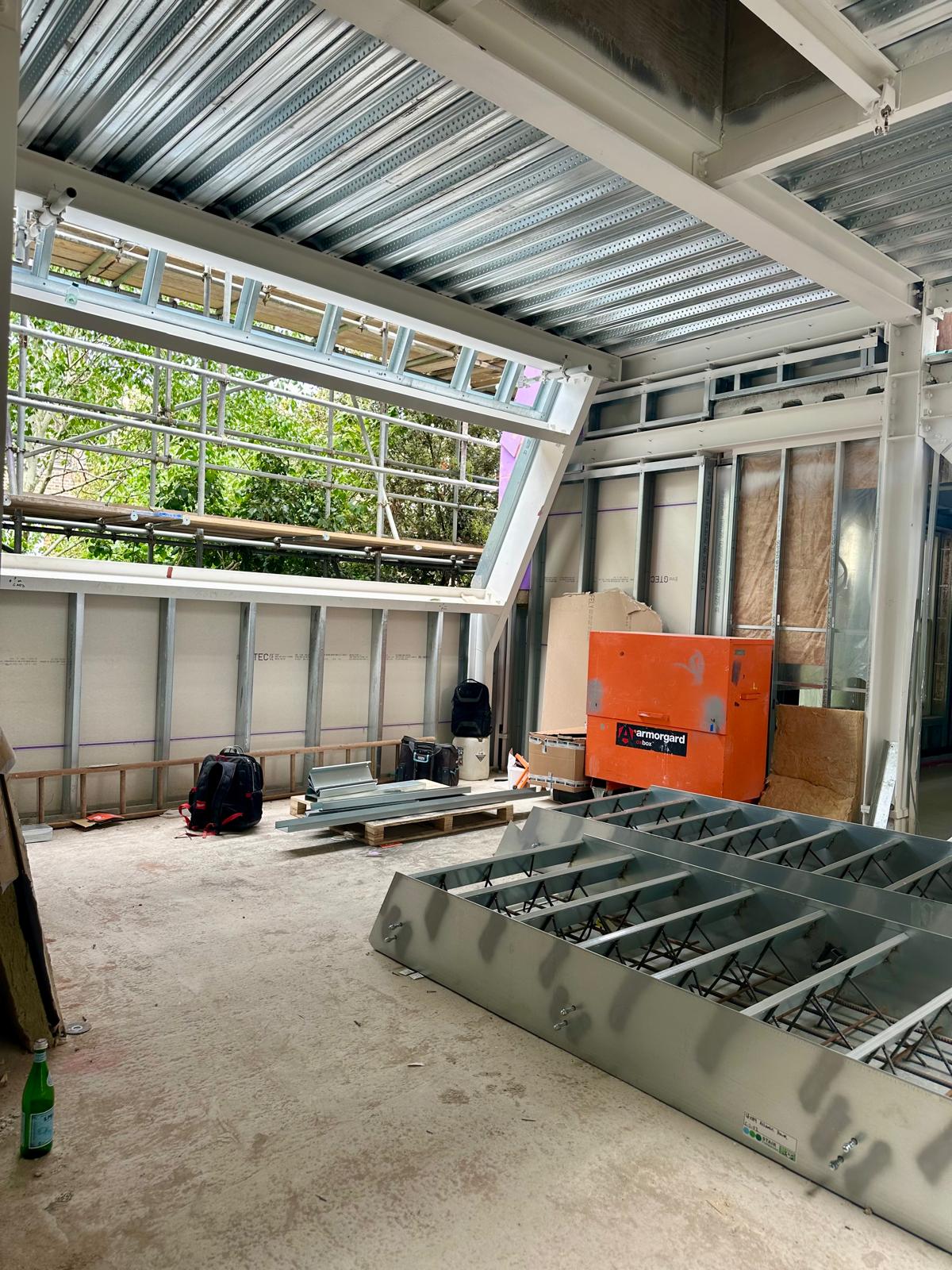

  • Atlantic House 2nd floor steels continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Scaffold to Atlantic House continued.
  • Lytham House 1st floor was poured.
  • Intumescent painting of steels continued.
  • SFS (steel formed sections) commenced in Atlantic House.
  • Lytham House basement slab was formed, with a pour scheduled for 18/11/24.
  • Bricklayers continued Atlantic house staircore works.
  • Movement, Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 18/11/24
  • Forming basement slab in Lytham House.
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House will continue.
  • M&E will commence on site 18/11/24.
  • Movement, Noise, Vibration and Dust monitoring on-going.
  • SFS (steel formed sections) will continue in Atlantic House.

Atlantic House Summary

  • Total Programme Duration: 90 weeks.
  • Week Reporting: 53.
  • Expected Completion Date: August 2025.

Atlantic House Anticipated Deliveries W/C 18/11/24

  • 2 flat-bed delivery of steel expected.
  • 1 hiab of blocks expected.
  • 5 concrete wagon expected.
  • 1 skip exchange expected.
  • Small deliveries (Vans & Cars) expected daily.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 11th November 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Lytham House first floor steel erection continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.

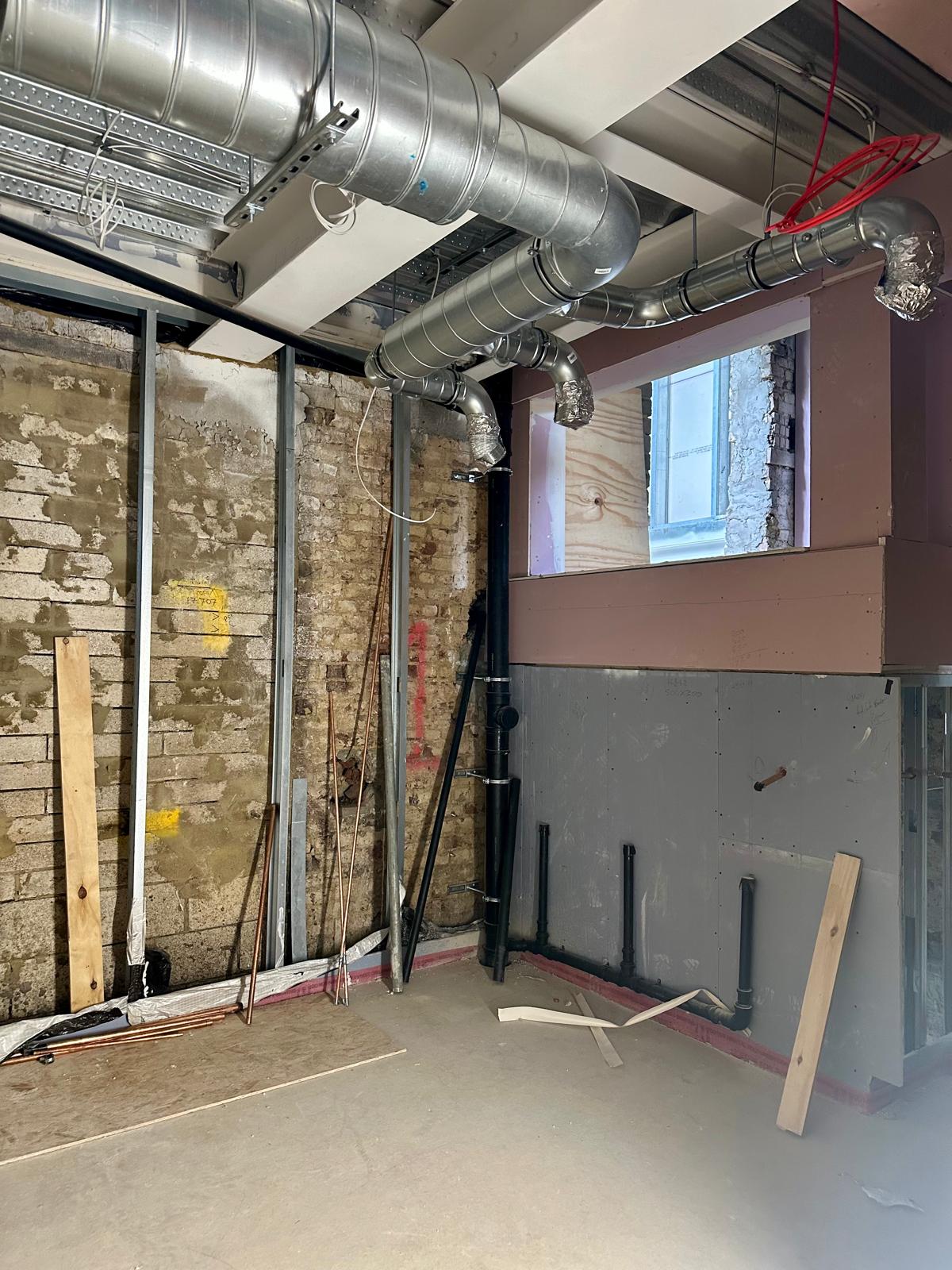

  • Drainage and waterproofing to the lift had been completed in Lytham House.
  • Scaffold to Atlantic House continued.
  • Atlantic House basement slab completed.
  • Bricklayers continued Atlantic house staircase works.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 04/11/24
  • Forming basement slab in Lytham House.
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House will continue.
  • Movement, Noise, Vibration and Dust monitoring ongoing.
  • SFS (steel formed sections) will commence on Atlantic House.
  • Intumescent spraying of Atlantic House steels will commence.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 4th November 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Lytham House First Floor steel erection continued.
  • Crane had continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Drainage & waterproofing works continued in Lytham House.
  • Ground beams & concrete slab for north stair tower were poured 01/11/24.
  • North elevation scaffold to Atlantic House commenced.
  • Waterproofing works continued in Atlantic House basement.
  • Movement, Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 04/11/24
  • Forming Basement slab in Lytham House.
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House will continue.
  • Movement, Noise, Vibration and Dust monitoring on-going.
  • Remainder of the basement slab in Atlantic House will be poured.

Atlantic House Summary

  • Total Programme Duration: 90 weeks.
  • Week Reporting: 51.
  • Expected Completion Date: August 2025.

Atlantic House Anticipated Deliveries W/C 28/10/24

  • 1 flat-bed delivery of steel expected.
  • 1 flat-bed delivery of metal decking expected.
  • 1 hiab of blocks expected.
  • 5 concrete wagon expected.
  • 1 skip exchange expected.
  • Small deliveries (Vans & Cars) expected daily.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – November 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place during the past month and the upcoming works that will take place in November at 1 St Albans Grove.

WORKS UPDATE OCTOBER
  • Lytham House Ground Floor slab had been poured.
  • Crane had continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • The waterproofing to the lift pit and basement slabs continued. • Steel Frame in Atlantic House was completed from GF to2nd floor.
  • Bricklayers continued the façade infill works &continued building the stair core in Atlantic House. • Façade restoration had commenced, with a ‘doff’ clean completed on Lytham House.
  • Stone and muck produced from groundworks &demolition removed from site.

UPCOMING WORKS FOR NOVEMBER

  • Lytham House steel frame will continue, with the First and Second floors due to be poured in November.
  • Metal decking to Lytham House will continue.• Lytham House basement slab is due to be poured during this period.
  • Steel erection in Atlantic House will commence during this period, with the first steel delivery scheduled for 09/10.
  • Façade restoration works will continue on both Atlantic& Lytham House.

Atlantic House Summary

  • Total Programme Duration: 90 weeks.
  • Week Reporting: 50-54.
  • Expected Completion Date: August 2025.

Atlantic House Anticipated Deliveries October

  •  5 muck-away lorries expected throughout the month.
  • 10 concrete wagons expected throughout the month.
  • 5 steel deliveries (HIAB Crane Lorry) expected throughout the month.
  • Small deliveries (Vans & Cars) expected daily.
  • 20 flat bed lorries expected throughout the month, for brick & blockwork.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 28th October 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Lytham House ground floor was poured on 25/10/24.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Drainage & waterproofing works continued in Atlantic House.
  • Retaining walls and columns for north stair tower were poured 25/10/24.
  • The installation of metal decking & mesh was completed.
  • Waterproofing works continued in Atlantic House basement.
  • Movement, Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 28/10/24
  • Drainage to continue in Lytham House basement now that the ground floor has been poured.
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House will continue.
  • Movement, Noise, Vibration and Dust monitoring on-going.
  • North elevation scaffold to Atlantic House will commence.

Atlantic House Summary

  • Total Programme Duration: 90 weeks.
  • Week Reporting: 50.
  • Expected Completion Date: August 2025.

Atlantic House Anticipated Deliveries W/C 28/10/24

  • 1 flat-bed delivery of steel expected.
  • 1 flat-bed delivery of metal decking expected.
  • 1 hiab of blocks expected.
  • 5 concrete wagon expected.
  • 1 skip exchange expected.
  • Small deliveries (Vans & Cars) expected daily.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 21st October
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Steel erecting in Lytham House had continued, with the ground floor steels completed 18/10/24.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Drainage & waterproofing works continued in Atlantic House.
  • Bricklayer started in Atlantic House, continuing façade infill works & the east stair core brickwork in Atlantic House.
  • Eastern stair core internal scaffold completed 07/10/24.
  • The installation of metal decking & mesh was completed.
  • Poured the ground, first & second floors of Atlantic House.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 21/10/24
  • Groundworks & superstructure to the northern stair tower in Atlantic House to continue.
  • Concrete pour to Lytham House ground floor will be completed 23/10/24.
  • Bricklayer will continue the façade infill works.
  • Façade restoration works on Lytham House will continue.
  • Steel erection in Lytham House will continue.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 14th October
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Steel erecting in Lytham House had commenced.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • The second delivery of steel for Lytham House arrived 10/10/24.
  • Drainage & waterproofing works continued in Atlantic House.
  • Bricklayer started in Atlantic House, continuing façade infill works & the east stair core brickwork in Atlantic House.
  • Eastern stair core internal scaffold completed 07/10/24.
  • The installation of metal decking continued, with two floors completed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 14/10/24
  • Groundworks to the northern stair tower in Atlantic House to continue.
  • Concrete pour to Atlantic House ground floor will be completed 14/10/24.
  • Bricklayer will continue the façade infill works.
  • Façade restoration works on Lytham House will continue.
  • Steel erection in Lytham House will continue.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 07th October
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Steel erecting in Atlantic House from ground floor – second has been completed.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • The first delivery of steel for Lytham House arrived 02/10/24.
  • Drainage & waterproofing works continued in Atlantic House.
  • Bricklayer started in Atlantic House, commencing façade infill works & the east stair core brickwork in Atlantic House.
  • The installation of metal decking started 04/10/24.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 07/10/24
  • Groundworks to the northern stair tower in Atlantic House to continue.
  • Eastern stair core internal scaffold to commence 7/10/24.
  • Bricklayer will continue the façade infill works.
  • Façade restoration works on Lytham House will continue.
  • Steel erection in Lytham House will continue.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – October 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place in September and the upcoming works that will take place in October at 1 St Albans Grove.

WORKS UPDATE FOR SEPTEMBER
  • All foundation pads have been poured in Lytham House.
  • Crane had continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • The first section of the basement slab in Atlantic House had been poured.
  • Steel Frame in Atlantic House commenced.
  • Bricklayers commenced the façade infill works & started building the staircore in Atlantic House.
  • Façade restoration had commenced, with a Doff clean completed on Atlantic House.
  • Stone and muck produced from groundworks & demolition removed from site.
UPCOMING WORKS FOR OCTOBER
  • Lytham House steel frame set to commence w/c 30/09/24.
  • Metal decking to Atlantic House will commence, with the first slab pour scheduled for 09/10/24.

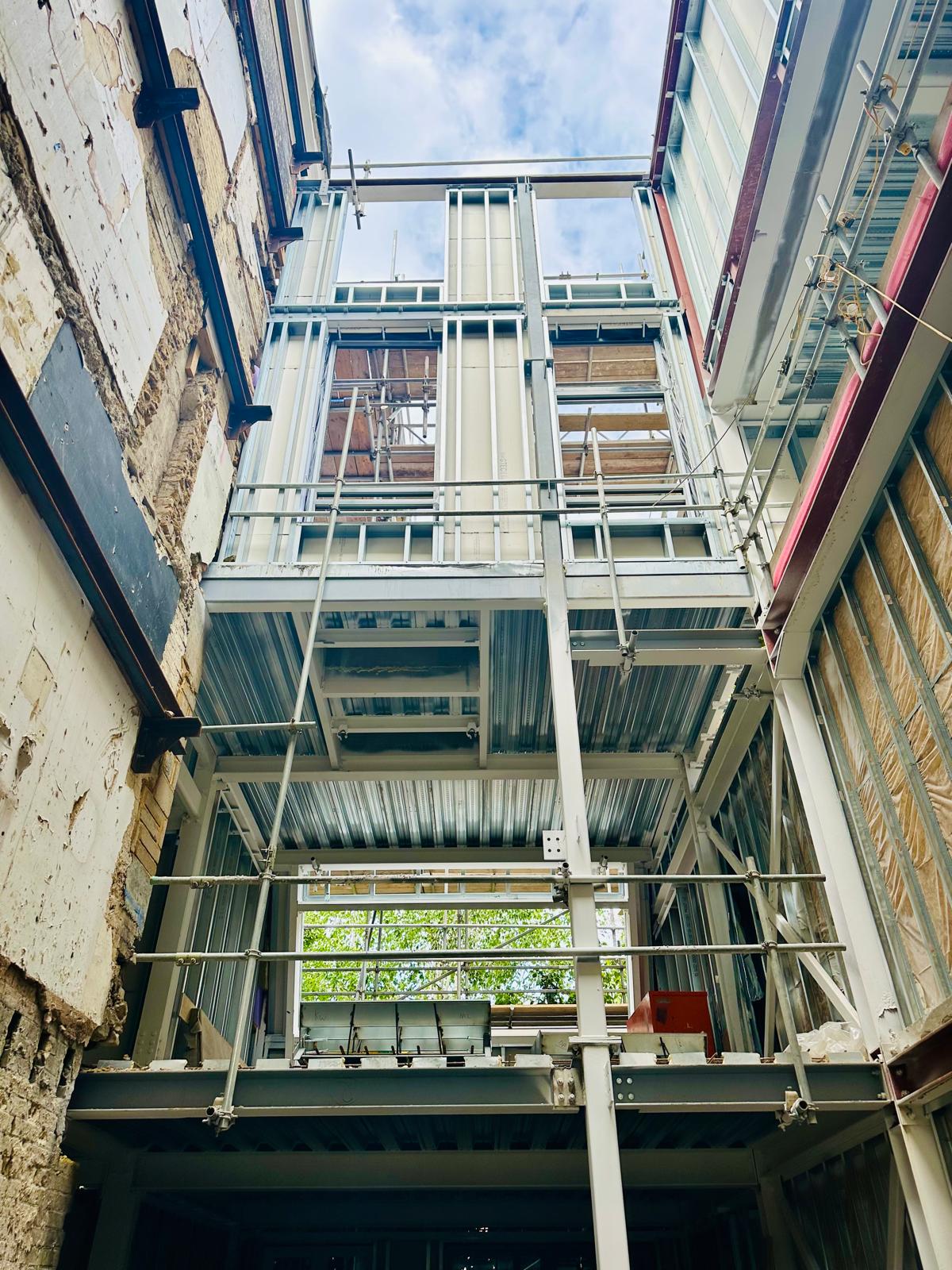

  • Steel erection in Atlantic House will commence, with the first steel delivery scheduled for 09/10/24.

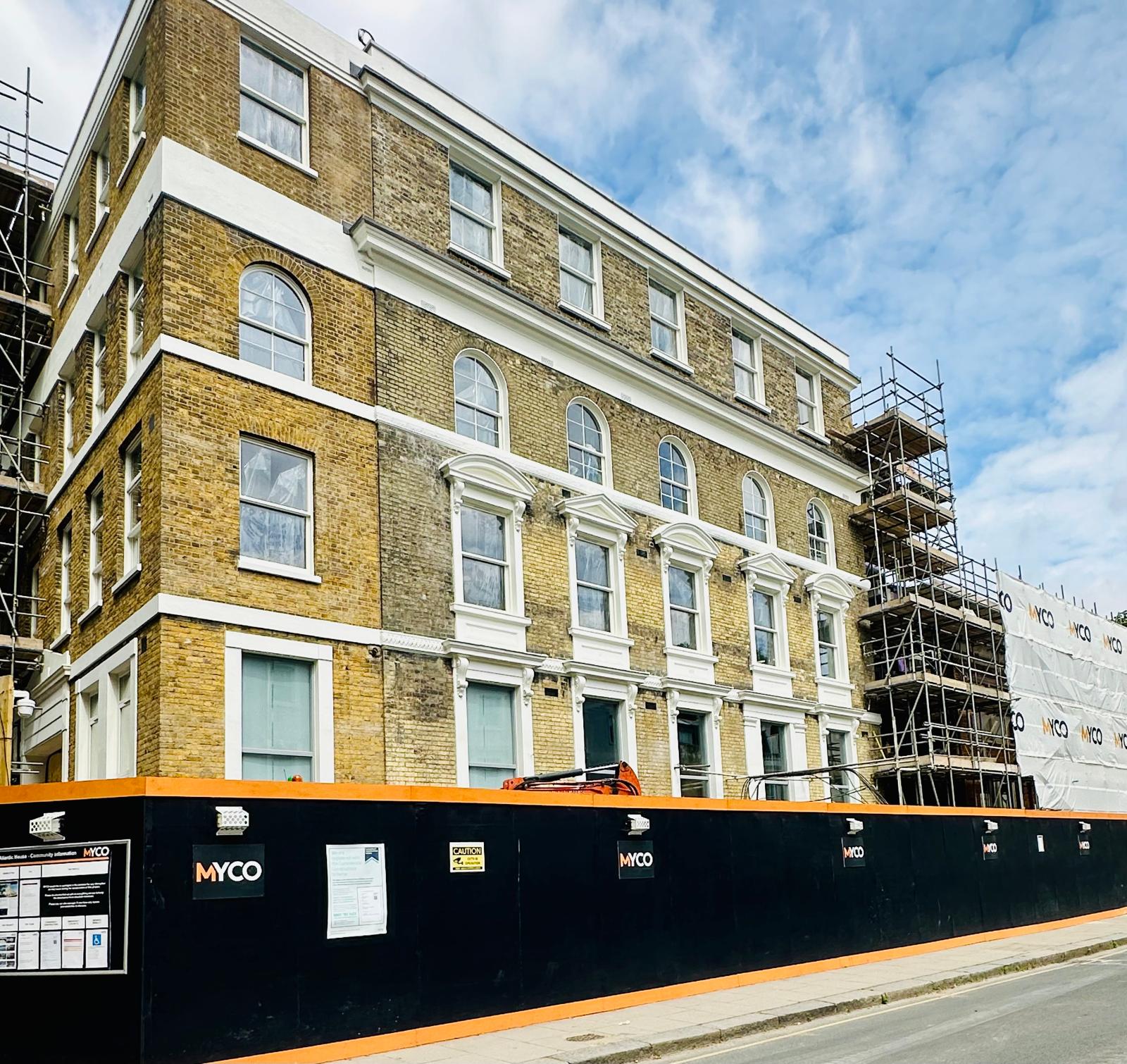

  • Façade restoration works will continue on Atlantic House & commence on Lytham House.

PROGRAMME SUMMARY

  • Total Programme Duration: 90 weeks.
  • Weeks Reporting: 46-50.
  • Expected Completion Date: August 2025.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 30th September
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Steel erecting in Atlantic House had continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • The fourth steel delivery had arrived onto site on the 23/09/24.
  • Drainage & waterproofing works continued in Atlantic House.
  • Bricklayer started in Atlantic House, commencing façade infill works.
  • Metal decking for Atlantic House slabs arrived 26/09/24.
  • Groundworks in Lytham House continued, with a second concrete pour completed on 23/09/24.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 30/09/24
  • Groundworks in Lytham House to continue, with a concrete pour scheduled for 26/09/24.
  • The steel delivery for Lytham House Atlantic House will arrive on site 30/09/24.
  • Bricklayer will continue the façade infill works.
  • Façade restoration works will commence on Lytham House 23/09/24.
  • Steel erection in Lytham House will commence.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 23rd September
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Steel erecting in Atlantic House had continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • The third steel delivery had arrived onto site on the 17/09/24.
  • Drainage & waterproofing works continued in Atlantic House.
  • First phase of façade restoration to Atlantic House completed 18/09/24.
  • Groundworks in Lytham House continued, with a concrete pour completed on 18/09/24.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report
UPCOMING WORKS FOR W/C 23/09/24
  • Groundworks in Lytham House to continue, with a concrete pour scheduled for 25/09/24.
  • The fourth delivery of steel for Atlantic House will arrive on site 23/09/24.
  • Bricklayer will mobilise on site, commencing façade infill works.
  • Façade restoration works will commence on Lytham House 23/09/24.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 16th September
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Demolition contractor had fully demobilised from site.
  • Steel erecting in Atlantic House had continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • The second steel delivery had arrived onto site on the 11/09/24.
  • Drainage & waterproofing works continued in Atlantic House.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 16/09/24
  • Groundworks in Lytham House to continue now demolition has been completed.
  • The third delivery of steel for Atlantic House will arrive on site 17/09/24.
  • A section of the Atlantic House basement slab will be poured.

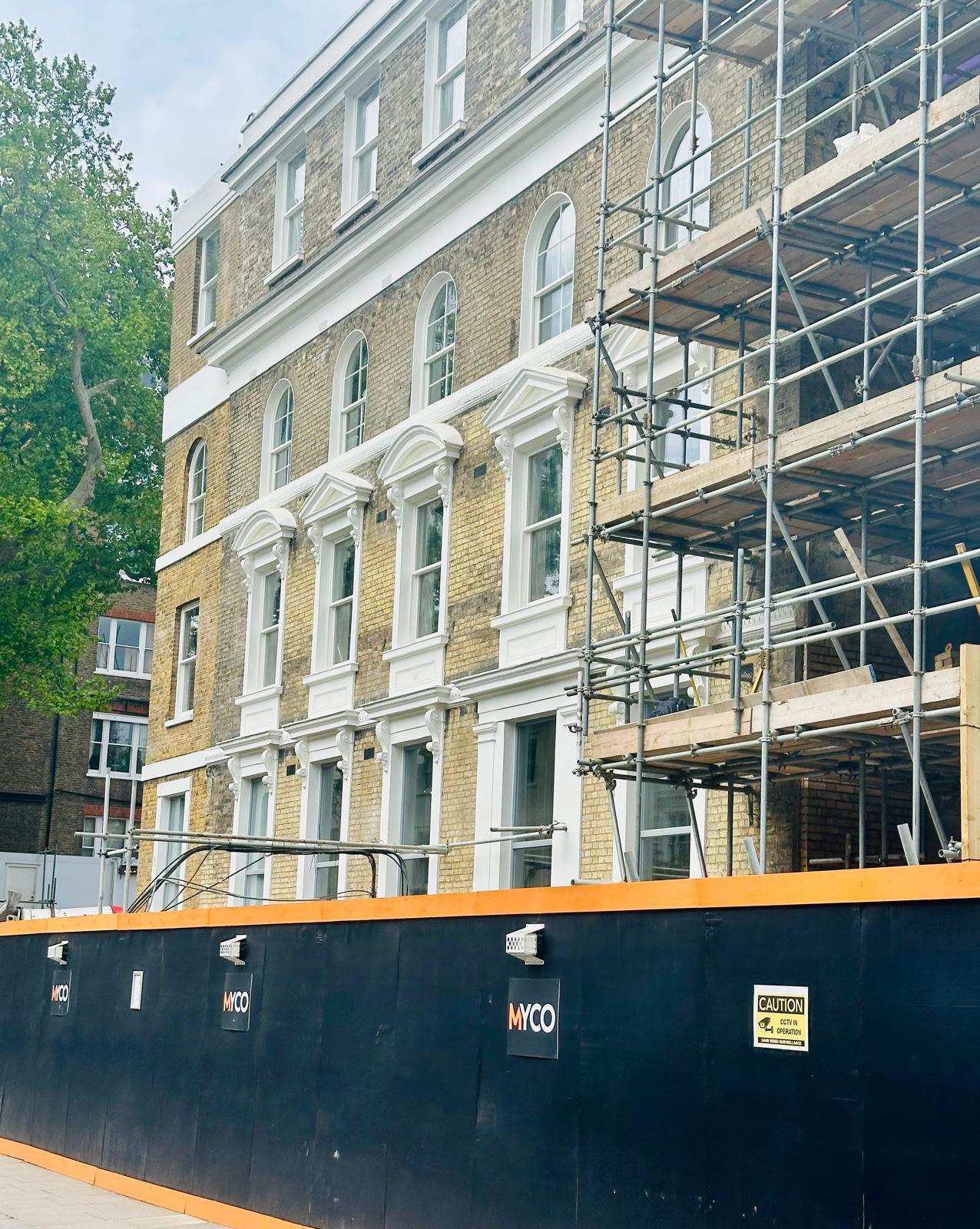

  • Façade restoration works will commence on Atlantic House 16/09/24.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 9th September
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Demolition contractor started to demobilise from site.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • The first steel delivery had arrived onto site on the 02/09/24.
  • Drainage & waterproofing works continued in Atlantic House.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 09/09/24
  • Groundworks in Lytham House to continue now demolition has been completed.
  • The second delivery of steel for Atlantic House will arrive on site 09/09.
  • A section of the Atlantic House basement slab will be poured. Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 2nd September
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House has been completed, in line with the programme.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • Drainage & waterproofing works continued in Atlantic House, preparing for the first section of the basement slab to be poured w/c 02/09.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 02/09/24
  • Groundworks in Lytham House to recommence, now demolition has been completed.
  • The first delivery of steel for Atlantic House will arrive on site 02/09.
  • Scaffolding will continue on the eastern end of Atlantic House, for our steel frame erection.
  • Movement, Noise, Vibration and Dust monitoring ongoing

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – September 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place in August and the upcoming works that will take place in September at 1 St Albans Grove.

WORKS UPDATE FOR AUGUST
  • All foundation pads & ground beams have been poured in Atlantic House.
  • The crane had continued its lifting operations, it has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Drainage in Atlantic House had commenced.
  • Internal demolition of Lytham House had continued, this work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Stone and muck produced from groundworks & demolition removed from site.
UPCOMING WORKS FOR SEPTEMBER
  • Drainage in Atlantic House to continue, with the first basement slab scheduled to be poured w/c 09/09/24.
  • Completion of the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Steel erection in Atlantic House will commence, with the first steel delivery scheduled for 02/09/24.
  • Façade restoration works will commence on Atlantic House.
  • Groundworks in Lytham House will recommence, once the internal demolition of Lytham House has been completed.

PROGRAMME SUMMARY

  • Total Programme Duration: 90 weeks.
  • Weeks Reporting: 38-42.
  • Expected Completion Date: August 2025.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 26th August
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House has continued, in line with the programme.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • Drainage & waterproofing works continued in Atlantic House.
  • Collection of the 24T excavator from site, 21/08/24.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 26/08/24
  • Internal demolition of Lytham House will be completed.
  • Drainage & waterproofing to continue in Atlantic House, in preparation for the first section of the basement slab.
  • Demolition contractor to demobilise from site.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 19th August
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued as planned.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • Groundworks continued as planned with pad foundations and ground beams being excavated, and rebar cages being made for the pads and beams.

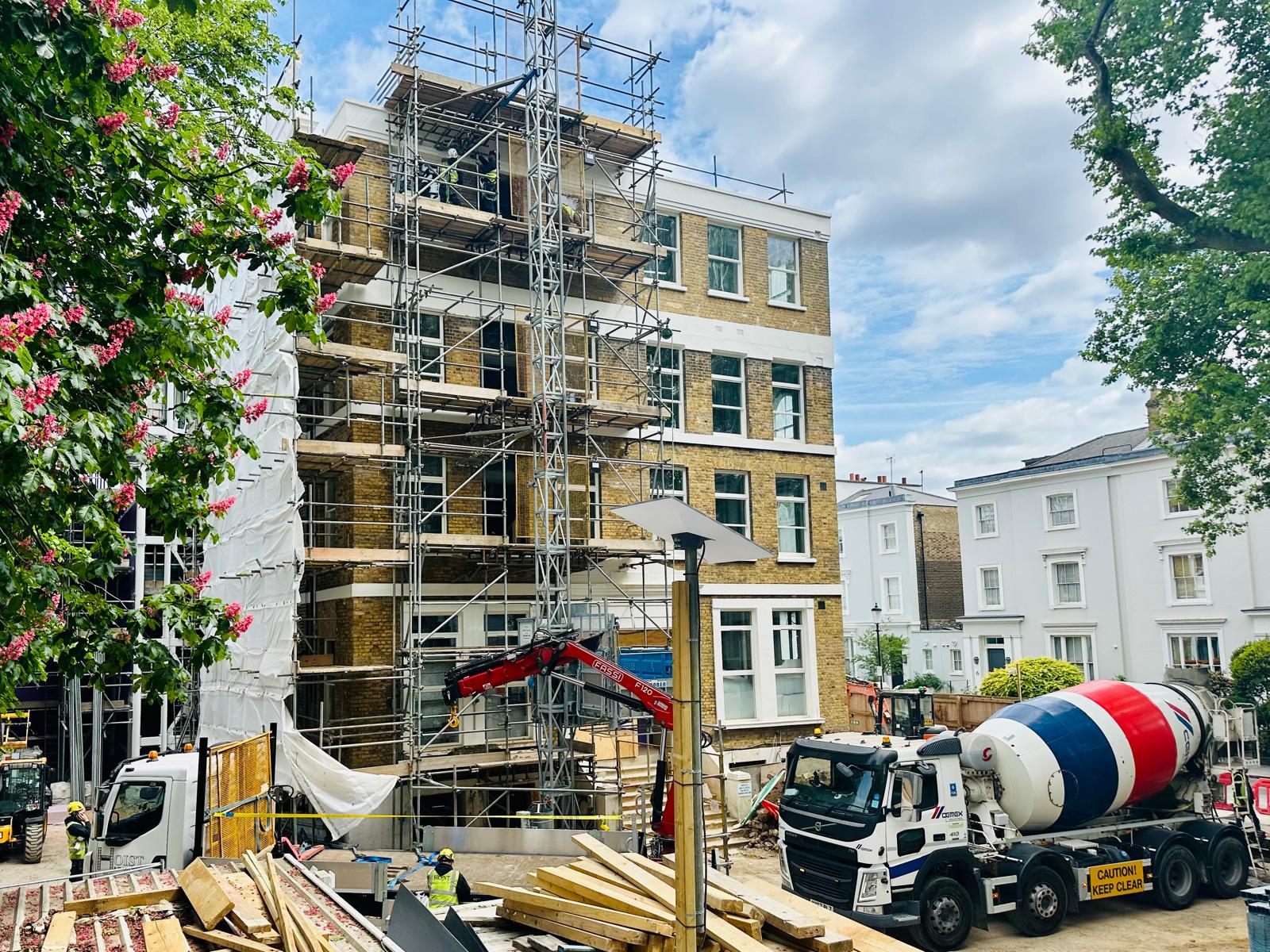

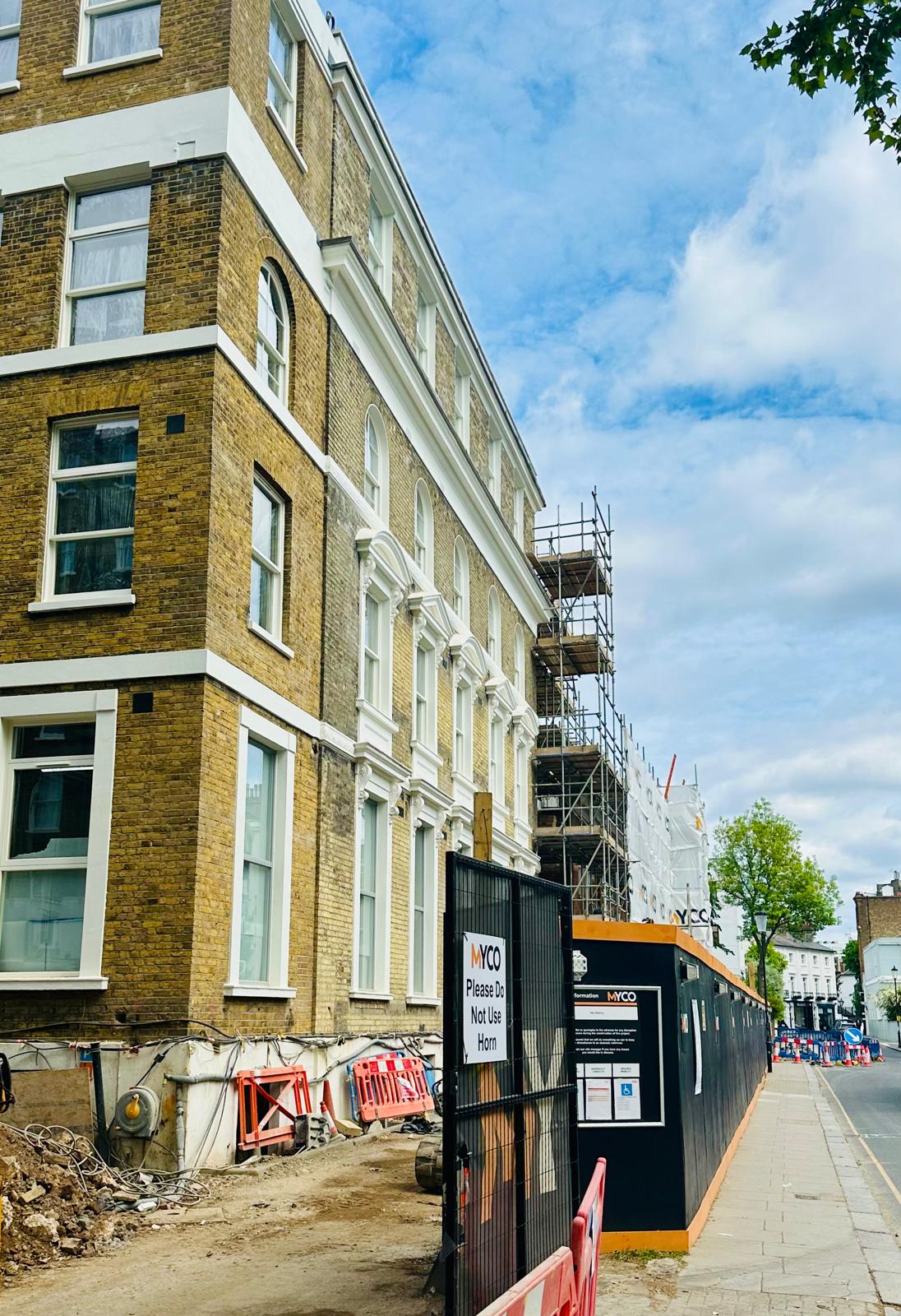

  • Steel erection for the façade retention has been completed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 19/08/24
  • Groundworks in Atlantic House to continue in line with the programme.
  • Internal demolition of Lytham House will be completed.
  • Continuation of the removal from site of the stone and muck produced from groundworks.
  • Drainage & waterproofing works will commence in Atlantic House.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 12th August
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued as planned.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • Groundworks continued as planned with pad foundations and ground beams being excavated, and rebar cages being made for the pads and beams.
  • Power switch over from the generator, to a permanent supply had been completed.
  • Steel erection for the façade retention has been completed.
  • 5nr scaffold bays struck on the North Elevation to release areas for the ground works to progress.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 12/08/24
  • Groundworks in Atlantic House to continue in line with the programme.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Continuation of the removal from site of the stone and muck produced from groundworks.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 5th August
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued as planned.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • Groundworks continued as planned with pad foundations and ground beams being excavated, and rebar cages being made for the pads and beams.
  • The installation of the monarflex sheeting to Lytham House has been completed.
  • Power switch over from the generator, to a permanent supply had been completed, with the generator now redundant and awaiting collection from site.
  • Steel erection for the façade retention has been completed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 05/08/24
  • Groundworks in Atlantic House to continue in line with the programme.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Continuation of the removal from site of the stone and muck produced from groundworks.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – August 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place in July and the upcoming works that will take place in August at 1 St Albans Grove.

WORKS UPDATE FOR JULY
  • Groundworks in Atlantic House had continued, as planned.
  • Crane continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • The façade retention structural works to Lytham House had been completed.
  • Internal demolition of Lytham House had commenced, this work does not involve any heavy demolition plantand will be demolished with smaller hand-tools.
  • Stone and muck produced from groundworks removed from site continued, as planned.
  • All demolition of Atlantic House had been completed, as planned.
  • Steel erection for the façade retention had continued as planned with ground floor underway.
  • UKPN and its subcontractor have completed the meter installation on the 25/07/24.
  • The installation of the Monarflex sheeting to Lytham House continued as planned.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR AUGUST
  • Groundworks in Atlantic House to continue, with drainage and concrete slabs being the next phase of works.
  • The site will perform a power switch over on 29/07/24, onto the temporary builders supply. This will eradicate the need for the generator, which is scheduled to be collected between 31/07/24 – 02/08/24.
  • The installation of the Monarflex sheeting to Atlantic House will be completed by the 30/07/24.
  • Steel erection for the façade retention will be completed by 31/07/24.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Continuation of the removal from site of the stone and muck produced from groundworks
  • Façade restoration works will commence on Atlantic House.
  • Movement, Noise, Vibration and Dust monitoring to continue as per the project protocols.

PROGRAMME SUMMARY

  • Total Programme Duration: 90 weeks
  • Weeks Reporting: 38-41
  • Expected Completion Date: August 2025

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 29th July
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued as planned.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site continued as planned.
  • Groundworks continued as planned with pad foundations and ground beams being excavated, and rebar cages being made for the pads and beams.
  • Steel erection for the façade retention continued as planned with ground floor underway.
  • UKPN and its subcontractor have completed the meter install on the 25/07/24.
  • The installation of the Monarflex sheeting to Lytham House continued as planned.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 29/07/24
  • Groundworks in Atlantic House to continue in line with the programme.
  • The site will perform a power switch over on 29/07/24, onto the temporary builders supply. The temporary generator will no longer be required and it is scheduled to be collected by the 02/08/24.
  • The installation of the Monarflex sheeting to Atlantic House will be completed by the 30/07/24.
  • Steel erection for the façade retention will be completed by 31st July
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Continuation of the removal from site of the stone and muck produced from groundworks.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 22nd July
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site.
  • Groundworks continued with pad foundations and ground beams poured on 17/07/24.
  • Steel erection for the façade retention continued, with level 1 now underway.
  • UKPN and its subcontractor have completed their temporary builders supply works, on 18/07/24.
  • Installation of the Monarflex wrapping to Lytham House is underway.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 22/07/24
  • Groundworks in Atlantic House to continue.
  • Installation of the Monarflex wrapping to Lytham House will be completed on 23/07/24.
  • Steel erection for the façade retention to continue, fitting steel beams on the remaining three elevations and levels.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • The stone and muck produced from groundworks removed from site will continue through the following week.
  • Movement, Noise, Vibration and Dust monitoring ongoing

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 15th July
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued.
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • Stone and muck produced from groundworks removed from site.
  • Groundworks continued with pad foundations and ground beams poured on 11/07/24.
  • Steel erection for the façade retention continued, with level 1 now underway.
  • Scaffold erection to the south & east elevations of Atlantic House completed on 12/07/24.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 15/07/24
  • Groundworks in Atlantic House to continue.
  • UKPN and its subcontractor are due to return to site on 16/07/24, to complete their temporary builders supply works, these works will be undertaken from 16/07/24- 18/07/24. As per the previous works carried out by UKPN on 20/06/24-29/06/24, there will be a footpath closure and suspended parking bays. Attached plan on page 2 of the newsletter, which has been approved by RBKC.
  • Steel erection for the façade retention to continue, fitting steel beams on the remaining three elevations and levels.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Stone and muck produced from groundworks removed from site. Monarflex to Lytham House scaffold continued & due to be completed on 19/07/24. Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 8th July
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House continued.
  • Crane has started its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site and there is no oversailing.
  • Stone and muck produced from groundworks removed from site.
  • Steel erection for the façade retention continued, with level 1 now underway.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 08/07/24
  • Groundworks in Atlantic House to continue.
  • Steel erection for the façade retention to continue, fitting steel beams on the remaining three elevations and levels.
  • Scaffold erection to the south & east elevations of Atlantic House due to start 09/07/24.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Stone and muck away of the material produced from groundworks to continue. Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 1st July 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Internal demolition of Lytham House commenced.
  • Scaffold crash deck to Lytham House completed.
  • UKPN started civils works to install a temporary power supply for the site.
  • Crane erection commenced on 29/06/24 and completed on 30/06/24.
  • Stone and subsoils recovered from groundworks removed from site.
  • Steel erection for the façade retention continued, with level 2 now underway.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 01/07/24
  • Groundworks in Atlantic House to continue.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Stone and subsoils recovered from groundworks removed from site.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

PROGRAMME SUMMARY

  • Total Programme Duration: 90 weeks
  • Week Reporting: 34
  • Expected Completion Date: August 2025

ANTICIPATED DEVLIVERIES W/C 01/07/24

  • 5 muck-away lorries expected.
  • 2 concrete wagons expected.
  • 1 steel delivery (HIAB Crane Lorry).
  • Small deliveries (Vans & Cars) expected daily.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – July 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place in June and the upcoming works that will take place in July at 1 St Albans Grove.

WORKS UPDATE FOR JUNE
  • Groundworks in Atlantic House had commenced.
  • Crane erection was successfully completed last weekend.
  • Lytham House façade retention steel frame continued, with two levels of internal steel beams installed.
  • Stone and muck produced from groundworks removed from site.
  • All demolition of Atlantic House had been completed.
  • Remaining internal demolition of Lytham House commenced.
UPCOMING WORKS FOR JULY
  • Groundworks in Atlantic House to continue.
  • Continuation on the internal demolition of Lytham House. This work does not involve any demolition plant and will be demolished with smaller hand-tools.
  • Lytham House façade retention will complete to fully enable demolition to complete.
  • Steel frame for Atlantic House due to be delivered to site late July.
  • Structural strengthening of Atlantic House continued.
  • Scaffold erection to Atlantic House to commence w/c 08/07/24.

PROGRAMME SUMMARY

  • Total Programme Duration: 90 weeks
  • Weeks Reporting: 34 to 37
  • Expected Completion Date: August 2025

ANTICIPATED DEVLIVERIES IN JULY

  • 15 muck-away lorries expected throughout the month.
  • 10 concrete wagons expected throughout the month.
  • 5 steel deliveries (HIAB Crane Lorry) expected throughout the month.
  • Small deliveries (Vans & Cars) expected daily.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 24th June
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane base enabling works completed.
  • Scaffold crash deck to Lytham House progressing.
  • UKPN undertaking roadworks this week.
  • Exported stone away from site throughout the week.
  • Steel erection for the façade retention continued, with level 2 now underway
  • Movement monitoring visit completed, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.
UPCOMING WORKS FOR W/C 24/06/24
  • Tower Crane erection booked for the weekend of 29th and 30th of June, 2-way traffic lights will be in operation and more parking bay suspensions. All permits are in place for this unavoidable weekend works.
  • Groundworks in Atlantic House to continue.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Demolition of Lytham House will commence 24/06/24.
  • Movement, Noise, Vibration and Dust monitoring ongoing

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 17th June
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane base enabling works continued.
  • Scaffold crash deck to Lytham House commenced.
  • Breaking out the second-floor slab to Atlantic House completed on 14/06/24.
  • Exported stone away from site throughout the week.
  • Steel erection for the façade retention continued, with level 3 completed on 13/06/24.
  • Movement monitoring visit completed, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.
UPCOMING WORKS FOR W/C 17/06/24
  • Crane base enabling works to continue.
  • Groundworks in Atlantic House to continue.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Delivery of steel beams scheduled for 11/06/24.
  • Exporting stone and material from site throughout the week.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 10th June
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • The first set of pad foundations in Lytham House were poured on 06/06/24.
  • Crane base enabling works commenced, set to be completed on 18/06/24.
  • Scaffold crash deck to Atlantic house completed.
  • Breaking out the second-floor slab to Atlantic House commenced.
  • Exported stone away from site throughout the week.
  • Steel erection for the façade retention continued.
  • Movement monitoring visit completed, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.
UPCOMING WORKS FOR W/C 10/06/24
  • Crane base enabling works to continue.
  • Groundworks in Atlantic House to continue.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Delivery of steel beams scheduled for 11/06/24.
  • Exporting stone and material from site throughout the week.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 3rd June
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • The seventh set of underpins in Lytham House were poured on 23/05/24.
  • Plant for crane base enabling works collected on 28/05/24 and 30/05/24.
  • Scaffold crash deck to Atlantic house commenced.
  • Exported stone away from site throughout the week.
  • Steel erection for the façade retention continued.
  • Movement monitoring visit completed, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.

UPCOMING WORKS FOR W/C 03/06/24

  • Underpinning within Lytham House to continue with a concrete pour scheduled for Thursday 06/06/24.
  • Groundworks in Atlantic House to continue, including reducing the ground level in Atlantic House, pouring new pad foundations, and setting drainage.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Groundworks for crane base to commence.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – June 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place in May and the upcoming works that will take place in May at 1 St Albans Grove.

WORKS UPDATE FOR MAY
  • Underpinning of the existing foundations in Lytham House continued.
  • Demolition of the eastern façade of Atlantic House was completed with all demolition plant collected from site.
  • Façade retention continued, with all external steel beams installed.
  • Crane base enabling works had been completed

UPCOMING WORKS FOR JUNE

  • Groundworks in Atlantic House to commence.
  • Tower crane installation scheduled for the 29/06/24 and 30/06/24. All works will be in conjunction with the traffic management plans which have been approved by RBKC.
  • Demolition of the roof and third floor of Lytham House scheduled for w/c 17/06/24. This work does not involve any demolition plant and will be demolished with hand-tools.
  • Internal façade retention on ground floor to floor two continued.
  • Structural strengthening of Atlantic House continued.
  • Demolition scaffold to the eastern façade of Atlantic House will be struck.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 27th May
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • The sixth set of underpins in Lytham House were poured on 23/05/24.
  • Demolition plant (high reach) was collected on Monday 20/05/24.
  • Demolition of the eastern façade of Atlantic House had continued.
  • Plant for the enabling works to the crane base arrived on 22/05/24.
  • Steel erection for the façade retention continued.
  • Two additional welfare units were delivered on 21/05/24.
  • Movement monitoring visit completed, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.

UPCOMING WORKS FOR W/C 20/05/24

  • Underpinning within Lytham House to continue with a concrete pour scheduled for Thursday 30/05/24.
  • Groundworks in Atlantic House to commence.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Demobilisation of crane base plant.
  • Movement, Noise, Vibration and Dust monitoring ongoing

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 20th May 2024
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • The fifth set of underpins in Lytham House were poured on 15/05/24 & 16/05/24.
  • Demolition plant (high reach) arrived on Tuesday 14/05/24.
  • Demolition of the eastern façade of Atlantic House recommenced.
  • Steel erection for the façade retention continued.
  • Movement monitoring visit completed, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.

UPCOMING WORKS FOR W/C 20/05/24

  • Underpinning within Lytham House to continue with a concrete pour scheduled for Thursday 23/05/24.
  • Collection of demolition plant (high reach). Please note that the date & time is subject to the movement traffic order issued by Highways and is yet to be agreed. MYCO will inform the residents upon receipt of the date & time.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Enabling works for the crane base.
  • Movement, Noise, Vibration and Dust monitoring ongoing

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 13th May 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • The third set of underpins in Lytham House were poured 02/05/24.
  • Scaffold adaptions on lifts 1 & 5 complete.
  • Steel delivery for façade retention on 02/05/24.
  • Movement monitoring visit complete, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.

UPCOMING WORKS FOR W/C 13/05/24

  • Underpinning within Lytham House continued with a concrete pour set for Thursday 16/05/24.
  • Arrival of demolition plant (highreach). The movement order for this machinery has been rescheduled for 13/05/24, with the scheduled arrival time on site at 05:00. The early delivery of plant is due to road safety. If this date / time changes, this will be communicated to all local residents immediately. All works will be in conjunction with the CTMP.
  • Steel erection for the façade retention continued, fitting steel beams on the remaining three elevations and levels.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 6th May 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • The third set of underpins in Lytham House were poured 02/05/24.
  • Scaffold adaptions on lifts 1 & 5 complete.
  • Steel delivery for façade retention on 02/05/24.
  • Movement monitoring visit complete, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.

UPCOMING WORKS FOR W/C 06/05/24

  • Underpinning within Lytham House continued with a concrete pour set for Friday 10/05/24.
  • Demolition contractor continuing the following works: importing & exporting stone / materials from site, installation of the piling rig mat & commencement of demolition to the eastern façade of Atlantic House.
  • Arrival of demolition plant (high reach). The movement order for this machinery has been scheduled on 08/05/24, with the scheduled arrival time on site at 05:00. The early delivery of plant is due to road safety. If this date / time changes, this will be communicated to all local residents immediately. All works will be in conjunction with the CTMP.
  • Piling contractor will mobilise on site on 13/05/24 to complete the contiguous piled wall along the northern boundary with Douro Place and the crane base piles. Anticipated time on site for these works are 3 weeks.
  • Movement, Noise, Vibration and Dust monitoring on-going.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – May 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place in April and the upcoming works that will take place in May at 1 St Albans Grove.

WORKS UPDATE FOR APRIL

  • Underpinning of the existing foundations in Atlantic & Lytham House has commenced, with the underpinning in Lytham House set to complete towards the latter weeks in May.
  • Scaffolding stairs have been completed, with all fourelevations of both the stairs and scaffolding being netted.
  • Structural strengthening works to the corners of Lytham House & chimneys have been completed.
  • Demolition contractor remobilised w/c 29/04/24, completing the loading out of hardcore & muck from site and installation of the piling rig mat.

UPCOMING WORKS FOR MAY

  • Demolition contractor will start demolition of the eastern façade of Atlantic House w/c 06/05/24. The demolition plant requires a movement order, which has been organised for 08/04/24 with expected arrival time onto site at 05:00. The early delivery of plant is due to road safety. If this changes, local residents will be informed immediately.
  • Underpinning of the existing foundations in Lytham House will continue.
  • Piling contractor will mobilise on site 13/05/24 to complete the contiguous piled wall along the northern boundary with Douro Place and the crane base piles. Anticipated time on site for these works are 3 weeks.
  • Façade retention will commence, with the first steel delivery booked in for 02/05/24.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 29th April 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • The second set of underpins in Lytham House were poured 25/04/24.
  • Debris netting to scaffold and haki stairs complete.
  • Timber bracing to Atlantic House & Lytham House post façade clean up continued.
  • Additional working scaffold lift to Lytham House eastern facade complete.
  • Scaffold handrails to Atlantic House roof complete.
  • Movement monitoring visit complete, no issues.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site, no issues.

UPCOMING WORKS FOR W/C 29/04/24

  • Underpinning within Lytham House will continue with a concrete pour set for Thursday 02/05/24.
  • Demolition contractor to recommence and complete the following: importing & exporting stone / demolition materials from site, installation of the piling rig mat & commencement of demolition to the eastern façade of Atlantic House.
  • The main demolition plant (requires a movement order & will be early hours as before). The date will be confirmed shortly in a separate notice to residents.
  • We anticipate the delivery towards the end of the week. All works will be in conjunction with the CTMP.
  • Movement, Noise, Vibration and Dust monitoring ongoing.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 22nd April 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • Enabling works in Lytham House complete.
  • The first set of underpins in Lytham House were poured 18/04/24.
  • Additional propping to existing steel beams in Lytham House complete.
  • Scaffold stairs to Lytham House have been complete.
  • Timber bracing to Atlantic House & Lytham House post façade clean up continued.
  • Netting to scaffolding started.
  • Movement monitoring visit complete.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site.

UPCOMING WORKS FOR W/C 22/04/24

  • Underpinning within Lytham House continued with 2nr concrete pours due for Wednesday 24/04/24 and Friday 26/04/24.
  • Hardcore removal from site.
  • Importing of stone into site for piling mat.
  • 1nr additional scaffold lift to eastern façade of Lytham House.
  • Netting to scaffold.
  • Movement monitoring on-going.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 15th April 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • The first phase of underpinning in Atlantic House has been complete as of 11/04/24.
  • Infill works to eastern façade had continued due for completion 15/04/24.
  • Exploratory works to the structure in Atlantic House had started.
  • Scaffold stairs to Lytham House started 09/04/24 due for completion 15/04/24.
  • Timber bracing to Atlantic House ground floor openings commenced post façade clean up.
  • Movement monitoring visit complete.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site.

UPCOMING WORKS FOR W/C 15/04/24

  • Enabling works within Lytham House complete for underpinning.
  • Underpinning within Lytham House commencing.
  • Completion of the infills to the eastern elevation of Lytham House.
  • Hardcore removal from site.
  • Importing of stone into site for piling mat.
  • Scaffold stairs complete 15/04/24.
  • Movement monitoring on-going.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 8th April 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • The tidying up of the northern façade of Atlantic House is now complete & a clean cut has been made post demolition works, in anticipation for the new superstructure.
  • Infill works to eastern façade of Lytham House have continued. Anticipated 12/04/24 completion date.
  • Underpinning to Atlantic House has started with 2nr concrete wagons on site Tuesday 2nd & Friday 5th April.
  • 1nr barrow hoist has been installed and powered up on the west elevation scaffold.
  • Movement monitoring visit complete.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site.

UPCOMING WORKS FOR W/C 08/04/24

  • Underpinning within Atlantic is set to continue with 2 more scheduled concrete pours w/c 08/04/24.
  • Underpinning to Lytham House is set to start once all enabling works are complete.
  • Infills to east elevation Lytham House will continue.
  • Façade clean up on the east elevation of Lytham House will continue.
  • 2nr concrete wagons are expected to be on-site w/c 08/04/24, they will be on site for 20 minutes each.
  • Movement monitoring on-going.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Monthly Update – April 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this month and the upcoming works that will take place in April at 1 St Albans Grove.

WORKS UPDATE FOR MARCH

  • Exploration works commenced to collate information regarding the existing substructure in both Atlantic & Lytham House.
  • Scaffolding to Lytham House (all four elevations) have been complete, in anticipation for façade retention.
  • Structural strengthening works to the corners of Lytham House & chimneys are 90% complete.
  • Northern façade of Atlantic House has been tidied up and a clean cut has been created in anticipation for the superstructure.

UPCOMING WORKS FOR APRIL

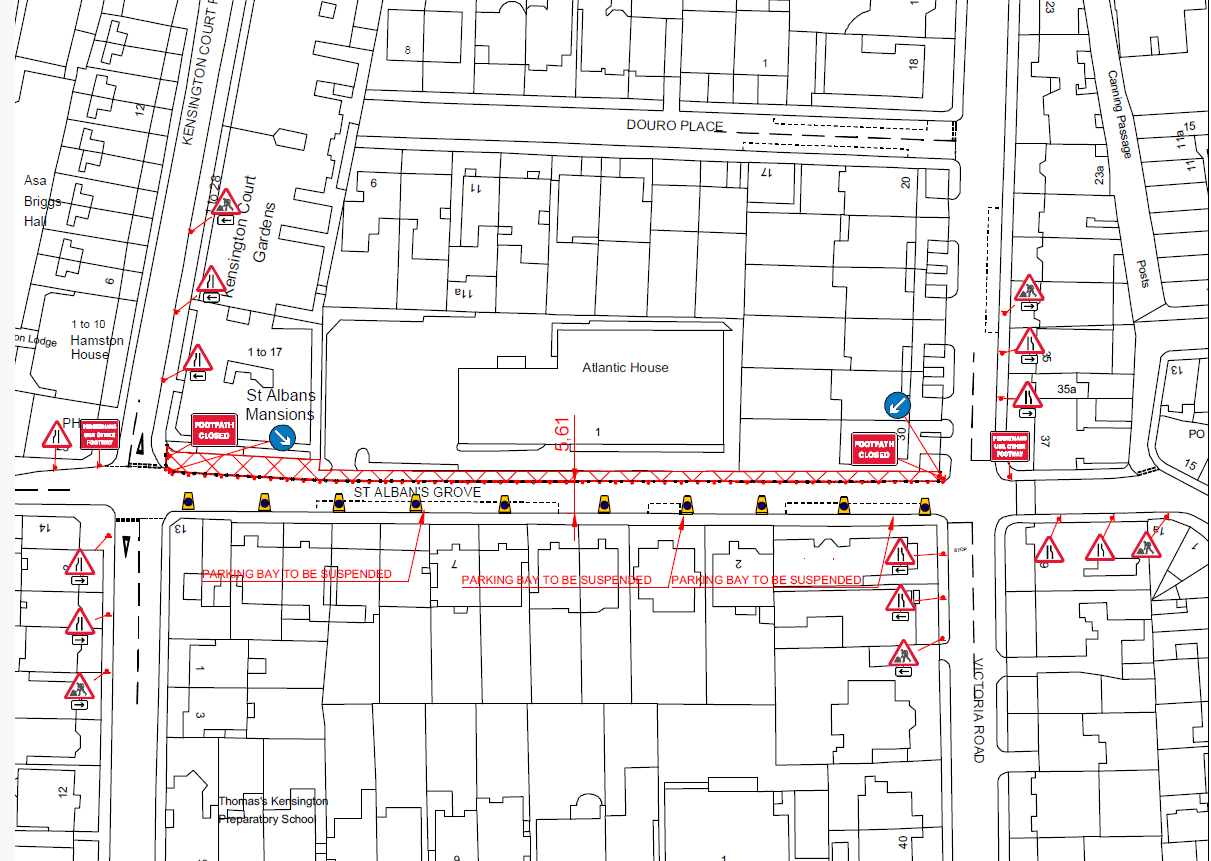

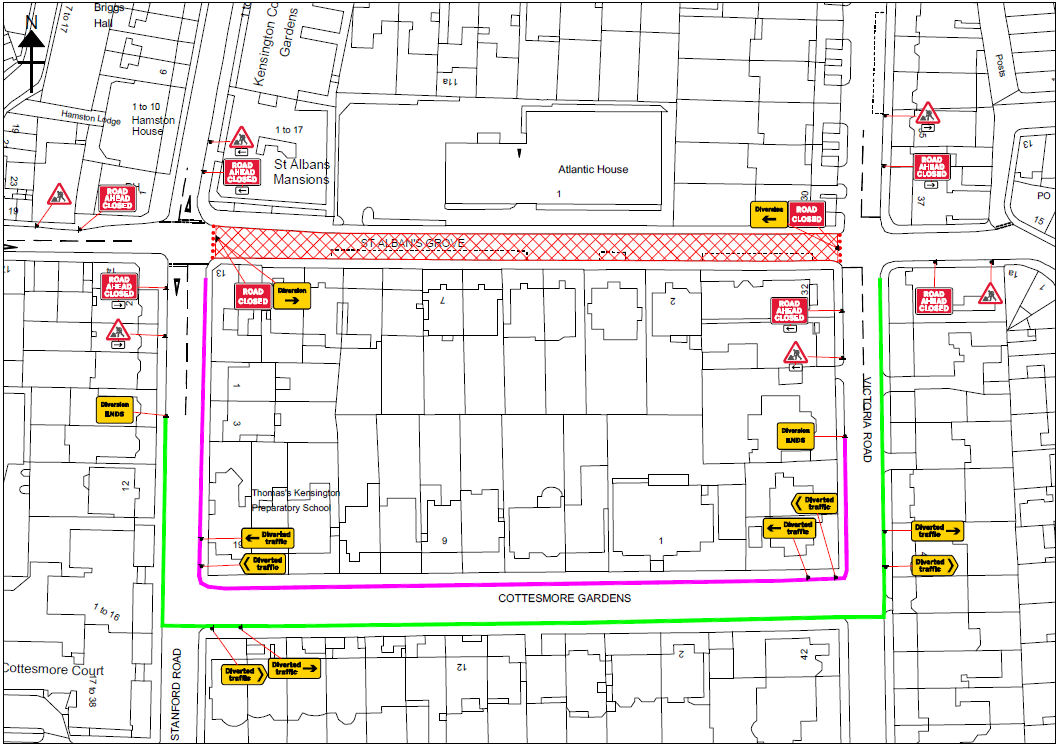

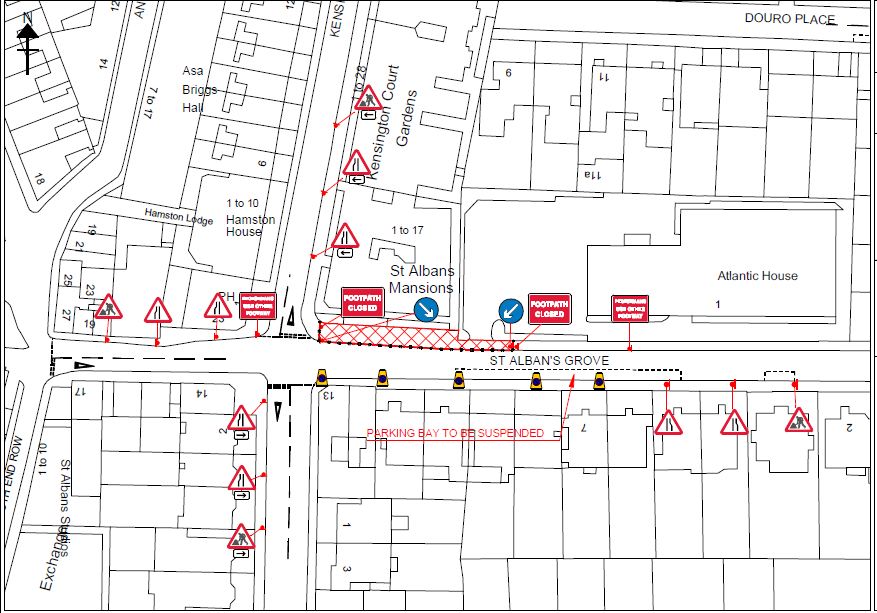

  • Contiguous piling wall to the northern boundary with Douro Place, aiming to start w/c 15/04/24. MYCO will confirm the precise commencement date for this activity a week in advance.
  • MYCO are aiming to start demolition of the remaining eastern façade to Atlantic House w/c 29/04/24. MYCO will confirm the precise commencement date for this activity a week in advance.
  • Underpinning of the existing foundations to both Atlantic & Lytham House will commence.
  • Infill brick/blockwork to the eastern façade of Lytham House will commence post demolition of the ‘link building’.
  • Civils works due to start 04/04/24 for our temporary builder’s supply (water). This will be within our site hoarding and adjacent to St. Albans Grove.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 2nd April 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • Northern façade of Atlantic House tidied up & a clean cut has been made post demolition works, in anticipation for the new superstructure.
  • Scaffold has been complete to the eastern elevation of Lytham House ready for infill works and façade tidy up next week.
  • Infill works to eastern façade of Lytham House has commenced. Anticipated 12/04/24 completion date.
  • Two floodlights have been installed in the site compound area.
  • Movement monitoring visit complete.
  • Dust, Noise & Vibration monitoring on-going daily via MYCO’s monitoring stations on site.

UPCOMING WORKS FOR W/C 02/04/24

  •  Underpinning due to commence in Atlantic & Lytham House.
  • Commencement of the contiguous pile wall is set to commence w/c 15/04/24. A 48-hour notice period will be given prior to the pilers start onsite.
  • Civils works due to start 04/04/24 for our temporary builder’s supply (TBS). This will be within our hoarding and adjacent to St. Albans Grove.
  • Concrete wagons will be pulling into site daily with underpinning set to commence, approximately 2nr wagons per-day, onsite for 20 minutes each.
  • Movement monitoring on-going.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 18th March 2024

15th March 2024

Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week (w/c 11th March) and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK

  • Exploration works to Atlantic House foundations ongoing.
  • Eastern elevation scaffold to Lytham House progressing.
  • Structural Works to Lytham House corners & chimneys progressing.
  • Additional vibration monitoring station along the northern boundary wall has been installed and is being calibrated ready for demolition to recommence.

UPCOMING WORKS FOR W/C 18/03/24

  • Structural works to Lytham House corners & chimneys.
  • East elevation scaffold to Lytham House completion.
  • Continue exploration works to existing pad & strip foundations to Atlantic House.
  • Commence exploratory works to Lytham House foundations.
  • w/c 25th March we anticipate recommencing demolition of Atlantic House eastern façade.

Thank you again for your patience and cooperation.

The Project Team

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Notification of the Programme of activities planned up until the 1st of April 2024

4th March 2024

Welcome to the March edition of the Atlantic House Construction Newsletter, keeping our neighbours updated on upcoming construction activities.

The developer, Thomas’, and the contractor, MYCO, remain committed to working with the community as construction progresses.

As members of the Considerate Constructors Scheme, it is important that we respect the community. With this in mind, the onsite team have put in place a number of robust measures to keep noise, dust and vibration to a minimum.

WORKS UPDATE FOR FEBRUARY

  • Demolition of Link building complete.
  • Broken out the basement slab to Atlantic House.
  • Propping to the existing floors & joists complete.
  • Structural works to both the corners of Lytham House and the chimneys.
  • Movement monitoring on-going on a weekly basis.
  • Scaffold strike to Atlantic House South Elevation.
  • Ground investigation works complete.
  • Turnstile installed & powered up.

UPCOMING WORKS IN MARCH

  • Groundworks / substructure is planned to start from 4th March 2024 involving extensions of the existing pad foundations new pad foundations and wall underpins.
  • Commencement of the ‘contiguous piling wall’ to the northern boundary with Douro Place is expected to start in April, shortly after Easter Bank Holiday. Duration expected to be 3 weeks.
  • Remaining Demolition of the east elevation is planned to start on Monday 25th March with an expected completion by April 12th, 2024.
  • Scaffold erection to the North and East elevations of Lytham House.
  • Structural works to Lytham House continued.

Thank you again for your patience and cooperation.

The Project Team

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Notification of the Programme of activities planned up until the 1st of March 2024

31st January 2024

Continuing from our previous correspondence, we would like to inform you about elements achieved to date and upcoming works:

Within the reporting period:

  • Installed demolition scaffold
  • Demolished Atlantic House
  • 70% demolition of Link Building

Outlined below is a list of works that we will be carrying out in February 2024:

  • Removal of demolition machinery from site
  • Installation of new site welfare
  • Temporary enabling works to Lytham House
  • Installation of piling mat
  • Temporary works to support the Lytham House

Please note: We would like to take this opportunity to make you aware that the delivery and collection of plant/machinery associated with demolition is subject to a movement order. As such, vehicular movements occur outside of standard working hours. We would like to apologise for any inconvenience this may cause.

If you wish to review and you have any comments or questions regarding the above, please contact  or via our feedback function here.

To view the letter that was sent to near neighbours please click here.

Notification of the Programme of activities planned up until the 26th January 2024

18th December 2023

Please see below the upcoming activities planned until the 26th January 2024 at Atlantic House, 1 St Albans Grove, London, W8 5PN. Continuing from our previous correspondence, we would like to inform you about elements achieved to date and forthcoming works.

Within the reporting period:

  • Commenced installation of the demolition scaffold.
  • Removed and braced all window and door openings.
  • Completed ecologist works (Bats).
  • Commenced internal demolition.
  • Appointed installation of noise, dust and vibration monitoring in line with Section 61 Requirements.
  • Carried out preparation works for demolition.

Outlined below is a list of works that we will be carrying out in January 2024:

  • Mobilisation of demolition machinery.
  • Commencement of external demolition.
  • Completing installation of the demolition scaffold.
  • Installation of noise and vibration monitoring in line with Section 61 Requirements.
  • Installation of site welfare.

Please note that that the operations at Atlantic House will be closed over the Christmas period between 22nd December 2023 – 2nd January 2024.

If you wish to review and you have any comments or questions regarding the above, please contact me directly via  or via our feedback function here.

To view the letter that was sent to near neighbours please click here.

Notification of the Programme of activities planned up until the 22nd December 2023

27th November 2023

Continuing from our previous correspondence, we would like to inform you about elements achieved to date and forthcoming works.

Within the reporting period:

  • We have continued to develop design.
  • Carried out baseline surveys to site, installing engineering datums and targets.
  • Obtained approval from the Royal Borough of Kensington and Chelsea on the Construction for all the pre-commencement conditions.

Outlined below is a list of works that we will be carrying out between now and the Christmas shutdown:

  • Installation of welfare concrete bases and site welfare set-up;
  • Underpinning of two boundary walls;
  • Demolition of tank rooms to the roof of Lytham House;
  • Installation of turnstiles and temporary works where required;
  • Mobilisation of machinery and demolition equipment to the site;
  • Demolition of the existing steel external stairs and closure of access points to them;
  • Installation of perimeter demolition scaffolding where necessary;
  • Installation of temporary services; and
  • Demolition of buildings to the rear of Lytham House.

As such, we would like to make you aware that our primary focus over the next few weeks will be on the mobilisation of the demolition process and associated enabling works.

If you wish to review and you have any comments or questions regarding the above, please contact MYCO directly via  or via our feedback function here.

Notification of the Programme for the activities planned up until the 31st October 2023

11th October 2023

Continuing from our previous updates, we would like to inform you about elements achieved to date and forthcoming works.

As outlined below, we have made some significant progress on site:

  • Completion of soft strip
  • Installation of signage and AED to the hoarding
  • Installation of CCTV and perimeter lighting
  • Material testing complete

As such, we would like to make you aware that our primary focus over the next few weeks will be on design development.

Site Set-Up

Once outstanding conditions are met, we will complete the installation of our site welfare facility for the main works.

Surveys and Investigations

Our site engineers will install levels, benchmarks and targets in the next week.

Demolition

The soft strip out works are now complete in preparation for main demolition, which will commence once required approvals are in place.

If you wish to review and you have any comments or questions regarding the above, please contact me directly via  or via our feedback function here.

To view the letter that was sent to near neighbours please click here.

Notification of the Programme for the activities planned up until the 30th September 2023

13th September 2023

Would like to inform you about the upcoming activities over the next weeks.
As outlined below, we have made some significant progress on site:

  • Removal of hedgerow and overgrowth
  • Removal of the boundary wall
  • Installation of hoarding, including pedestrian and vehicular access
  • Installation of temporary welfare facility
  • Gas disconnection by Cadent

As such, we would like you to be aware of the following activities in the coming period:

Site Set-Up
Site set up works to continue as follows:

  • Installation of pedestrian turnstile
  • Installation of additional security cameras and hoarding lighting
  • Safety signage to be mounted on the hoarding at the site entrance
  • Installation of an AED to the hoarding
  • Installation of hardstanding and ground preparation to commence for the overall site welfare facility

Surveys and Investigations

Material testing and surveys have now been carried out for which we await results. This will enable us to finalise design elements in relation to the final demolition and build process.

Demolition

The soft strip out works are currently ongoing with a planned completion by the end of the month prior to commencement of main demolition works.

If you wish to review and you have any comments or questions regarding the above, please contact me directly via  or via our feedback function here.

To view the letter that was sent to near neighbours please click here.

CTMP CONSULTATION

August 2023

We have updated the Construction Traffic Management Plan (CTMP) that was sent out for consultation on the 5th of July. The updated CTMP has been issued to reflect the minor scheme amendments that were presented to residents during the public exhibition drop-in event on the 19th of July 2023.

To view the updated CTMP please click here.

To view MYCO’s recent notification letter, sent to near neighbours, regarding the updated CTMP, click here.

Project Activities: July to September

July 2023

As part of Thomas’s London Day School and MYCO’s commitment to responsible construction practices, we are pleased to inform you about the planned activities for the upcoming four weeks at 1 St. Alban’s Grove. Please take note of the following important dates and actions:

  1. Mobilisation and Site Set-Up:
  • Start Date: Monday 31st July.
  • Duration: 7 weeks (until approximately mid-September)

During this initial stage of the project, we will be focused on preparing the site for development. The subsequent actions will take place:

  • Erecting a new hoarding line to secure the site (the hoarding will be further adopted to accommodate the needs of each phase of the construction phases).
  • Setting up a temporary welfare unit at the location specified in the layout below.

  • Clearing the site of any debris left by the enabling works contractor and progress with establishing MYCO’s site offices and welfare facilities.
  • Following site setup, a demolition scaffold will be set up around the building, a roll-on/roll-off 20-yard skip will be set up in the compound area and the soft strip will commence with rubbish going direct to the skip via a rubbish chute.
  1. Surveys and Investigations:
  • Start Date: Upon possession of the site set-up.
  • Actions:
    • Conduct a comprehensive site survey to confirm levels, boundaries, and plot positioning.
    • Verify active and inactive utilities on site to ensure all existing services have been disconnected by the demolition contractor, except for a water main utilized for temporary builder’s services.
  1. Structural Demolition:
  • Start Date: September 2023. (Amended: October 2023)
  • Note: There will be no site construction activities during the first 4 weeks.

For any inquiries or comments regarding the above activities, please feel free to contact us directly via the online feedback function or at .

We value your understanding and cooperation during this construction phase and strive to keep you informed about the progress of the Thomas’s Kensington project. Thank you for your support as we work towards creating a positive impact in the community.

The above text is an amended version of MYCO’s recent notification letter, sent to near neighbours, regarding the programme for the activities planned between Monday 31st July and Friday 1st September. To view the letter, click here.

Introducing MYCO

June 2023

We are delighted to announce the appointment of MYCO as the contractor for this project. MYCO has an impressive track record of delivering projects in the area, including the recent completion of the 197 High Street Kensington scheme. Situated on a prominent corner plot along Kensington High Street, this project posed logistical challenges due to its proximity to busy pedestrian and vehicular thoroughfares. Careful planning and management were crucial to adhere to the requirements set by RBKC.

020 3848 8777
https://mycoltd.co.uk/
3rd Floor, Godliman House, 21 Godliman Street, London, EC4V 5BD

For more information on MYCO and the construction programme for 1 St Albans Grove please click here.

Weekly Update – w/c 27th January 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • M&E installation continued to progress in Atlantic House and started within Lytham House basement.
  • Lytham House roof steel erection continued, with a pour scheduled for w/c 27/01/25.

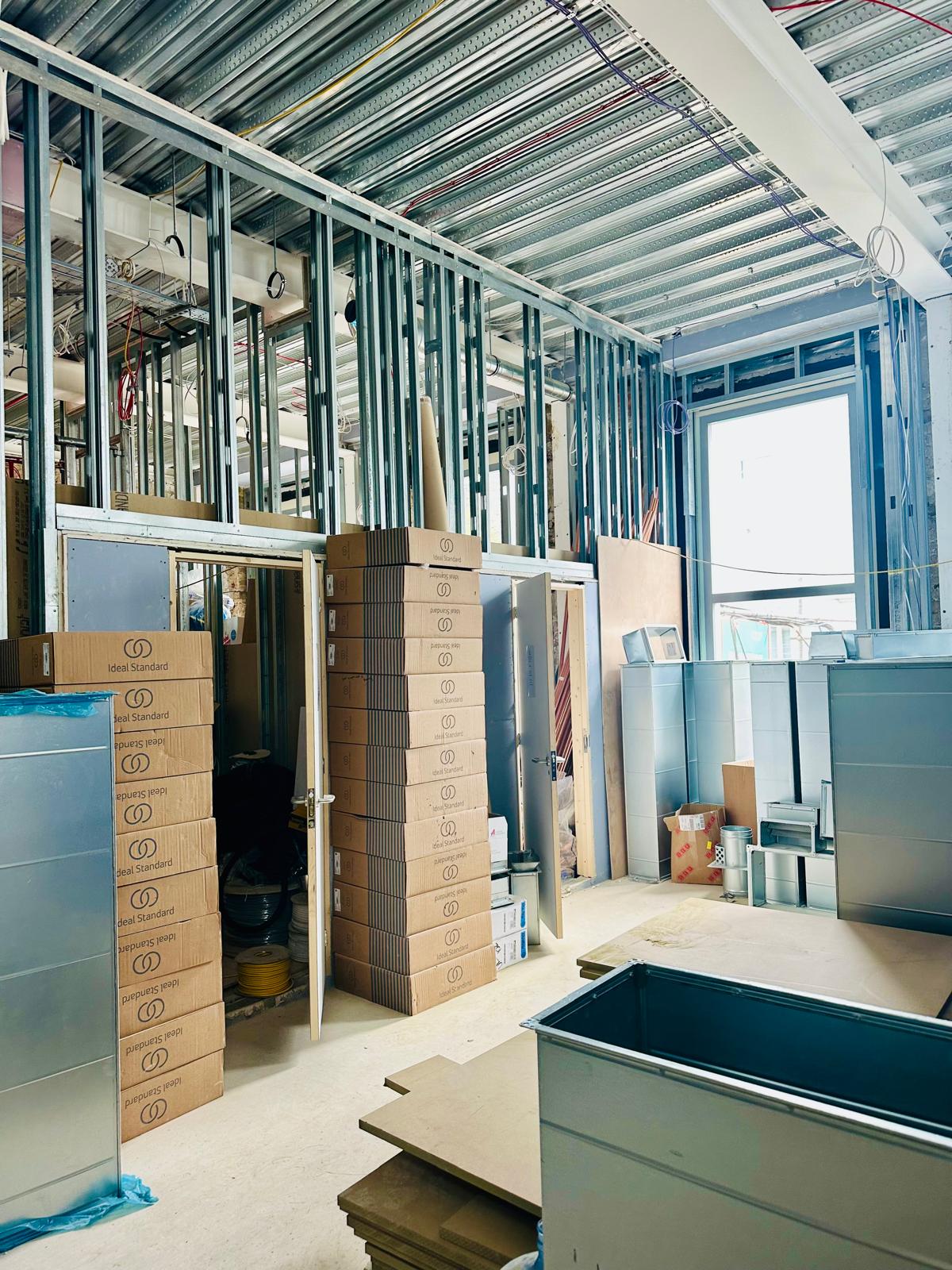

  • Internal partitions continued within Atlantic House.
  • Atlantic House cladding sheathing board progressed.
  • Stair erection in the east staircase of Atlantic House was completed.
  • Lytham House lift shaft walls progressed.
  • Façade restoration works commenced on Lytham House.
  • Structural works to new basement sub-station continued.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 27/01/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Link Building will continue.
  • Steel erection in Atlantic House will be completed.
  • Movement continue on the Atlantic House Terrace.
  • Structural works to new basement sub-station will be completed.
  • Waterproofing will continue in Atlantic House basement.
  • M&E installation continued to progress in Atlantic & Lytham House basement.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 13th January 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.

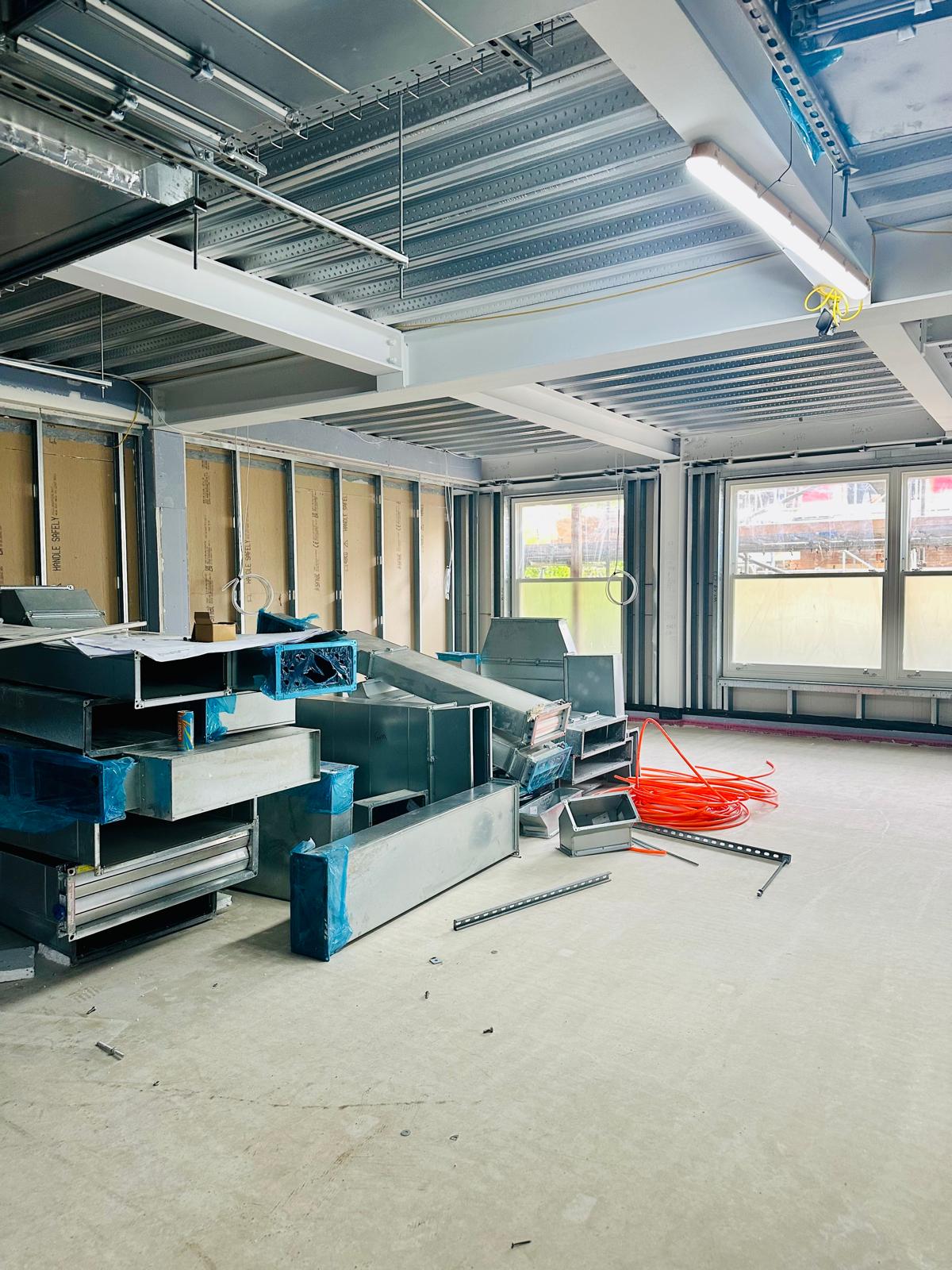

  • M&E installation continued to progress in Atlantic House.
  • Lytham House roof steel erection commenced.
  • Intumescent painting of steels continued.
  • Atlantic House cladding sheathing board progressed.
  • Lytham House lift shaft walls progressed.
  • Structural works to new basement sub-station continued.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 13/01/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Lytham House and Atlantic House will continue.
  • Stair erection in the east staircore of Atlantic House will be completed.
  • Movement, Noise, Vibration and Dust monitoring ongoing.
  • Façade restoration works will commence.
  • Internal partitions will commence in Atlantic House.
  • Structural works in the Substation will be completed.
  • Bricklayer will commence in the Substation.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 06 February 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • M&E installation continued to progress in Atlantic House and Lytham House.
  • Lytham House roof slab will be completed 7th Feb.
  • Link Building and North Stair Core superstructure has progressed.
  • North boundary retaining wall is nearing completion.
  • Internal partitions continued within Atlantic House & Lytham House.
  • Atlantic House cladding sheathing board progressed.
  • Façade restoration works progressed on Lytham House.
  • Structural works to new basement sub-station completed.

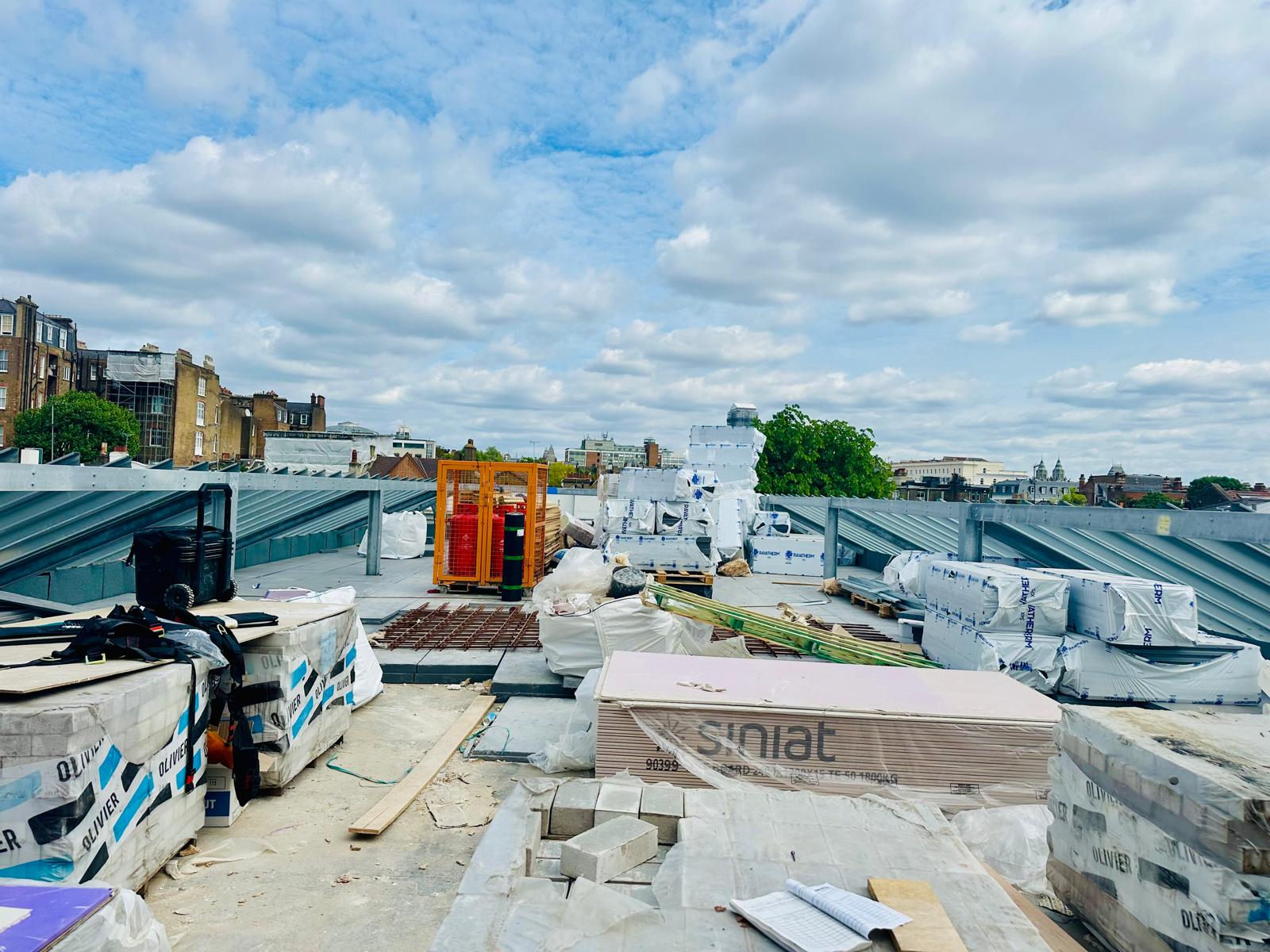

  • Roof membranes to Atlantic House progressed.
  • Brick façade infills progressed.
  • Waterproofing to basement areas has progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 10/02/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Link Building will continue.
  • Brickwork commencing on the Atlantic House Terrace.
  • Movement, Noise, Vibration and Dust monitoring ongoing.
  • Fit-out works to new basement sub-station will be progressing.
  • M&E installation continues to progress in Atlantic & Lytham House.
  • Internal partitions continue to progress in Atlantic & Lytham House.
  • Window installation to Lytham House will commence.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 20th January 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • M&E installation continued to progress in Atlantic House and started within Lytham House basement.
  • Lytham House roof steel erection continued, with a pour scheduled for 20/01/25.
  • Internal partitions continued within Atlantic House.
  • Atlantic House cladding sheathing board progressed.
  • Stair erection in the east staircase of Atlantic House was completed.
  • Lytham House lift shaft walls progressed.
  • Façade restoration works commenced on Lytham House.
  • Structural works to new basement sub-station continued.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 20/01/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Link Building will continue.
  • Steel erection in Atlantic House will be completed.
  • Roof of Lytham House will be poured.
  • Brickwork commencing on the Atlantic House Terrace.
  • Movement, Noise, Vibration and Dust monitoring ongoing.
  • Structural works to new basement sub-station will be completed.
  • Waterproofing will commence in Atlantic House basement.
  • M&E installation continued to progress in Atlantic & Lytham House basement.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Weekly Update – w/c 27th January 2025
Continuing from our previous correspondence, we would like to inform you about the works that have taken place this week and the upcoming works that will take place next week at 1 St Albans Grove.

WORKS UPDATE FOR LAST WEEK
  • Crane has continued its lifting operations, the crane has zonal restrictions, meaning it can only lift within the parameters of our site, and there is no oversailing.
  • M&E installation continued to progress in Atlantic House and started within Lytham House basement.
  • Lytham House roof steel erection continued, with a pour scheduled for w/c 27/01/25.
  • Internal partitions continued within Atlantic House.
  • Atlantic House cladding sheathing board progressed.
  • Stair erection in the east staircase of Atlantic House was completed.
  • Lytham House lift shaft walls progressed.
  • Façade restoration works commenced on Lytham House.
  • Structural works to new basement sub-station continued.
  • Brick façade infills progressed.
  • Movement, Dust, Noise & Vibration monitoring ongoing daily via MYCO’s monitoring stations on site, with no issues to report.
UPCOMING WORKS FOR W/C 27/01/25
  • Bricklayer will continue the façade infill works.
  • Steel erection in Link Building will continue.
  • Steel erection in Atlantic House will be completed.
  • Movement continue on the Atlantic House Terrace.
  • Structural works to new basement sub-station will be completed.
  • Waterproofing will continue in Atlantic House basement.
  • M&E installation continued to progress in Atlantic & Lytham House basement.

Contact MYCO:

Contact Thomas’s Kensington

To view the letter that was sent to near neighbours please click here.

Lorem ipsum dolor sit amet, consectetur adipiscing elit. Ut elit tellus, luctus nec ullamcorper mattis, pulvinar dapibus leo.

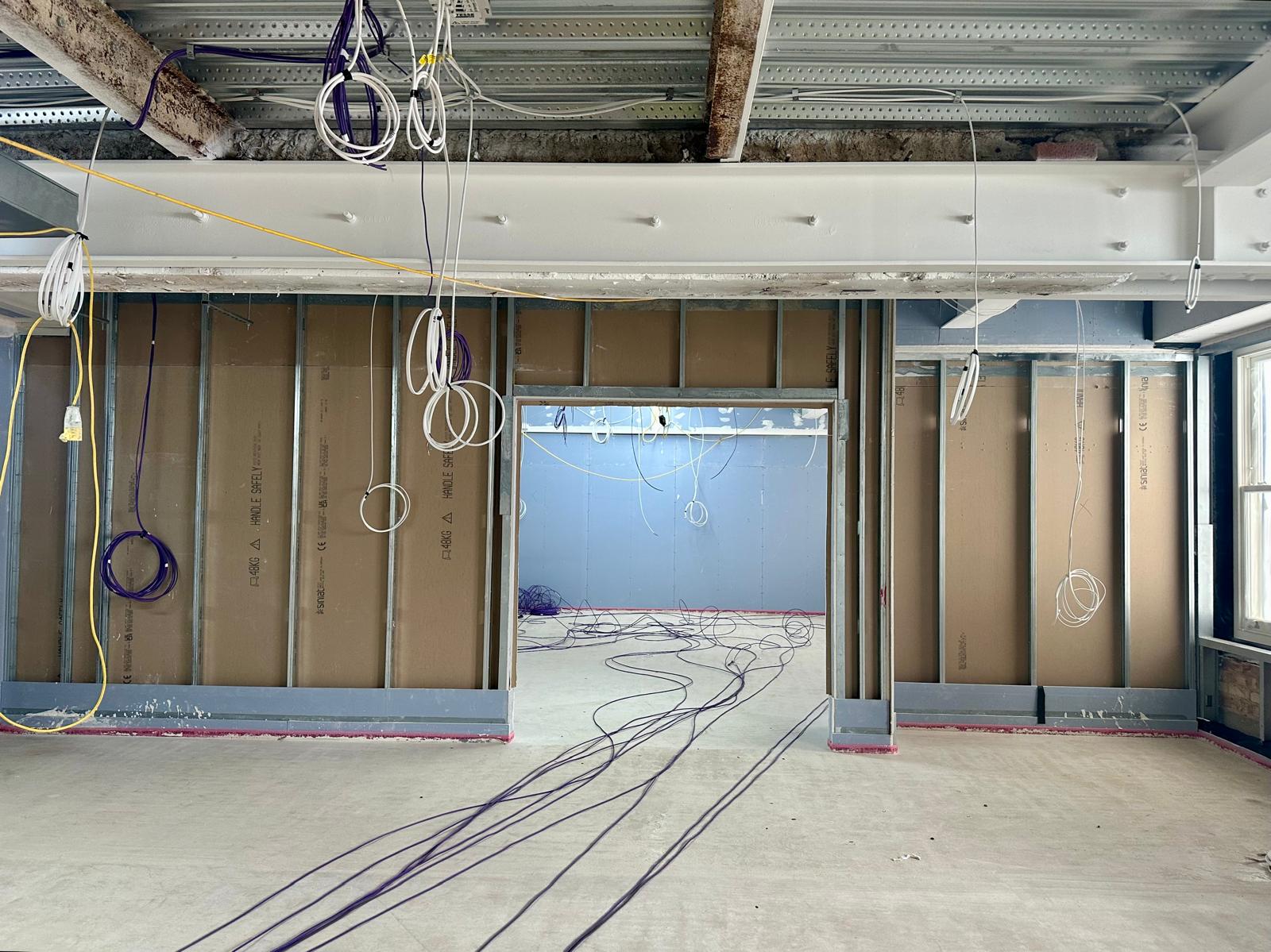

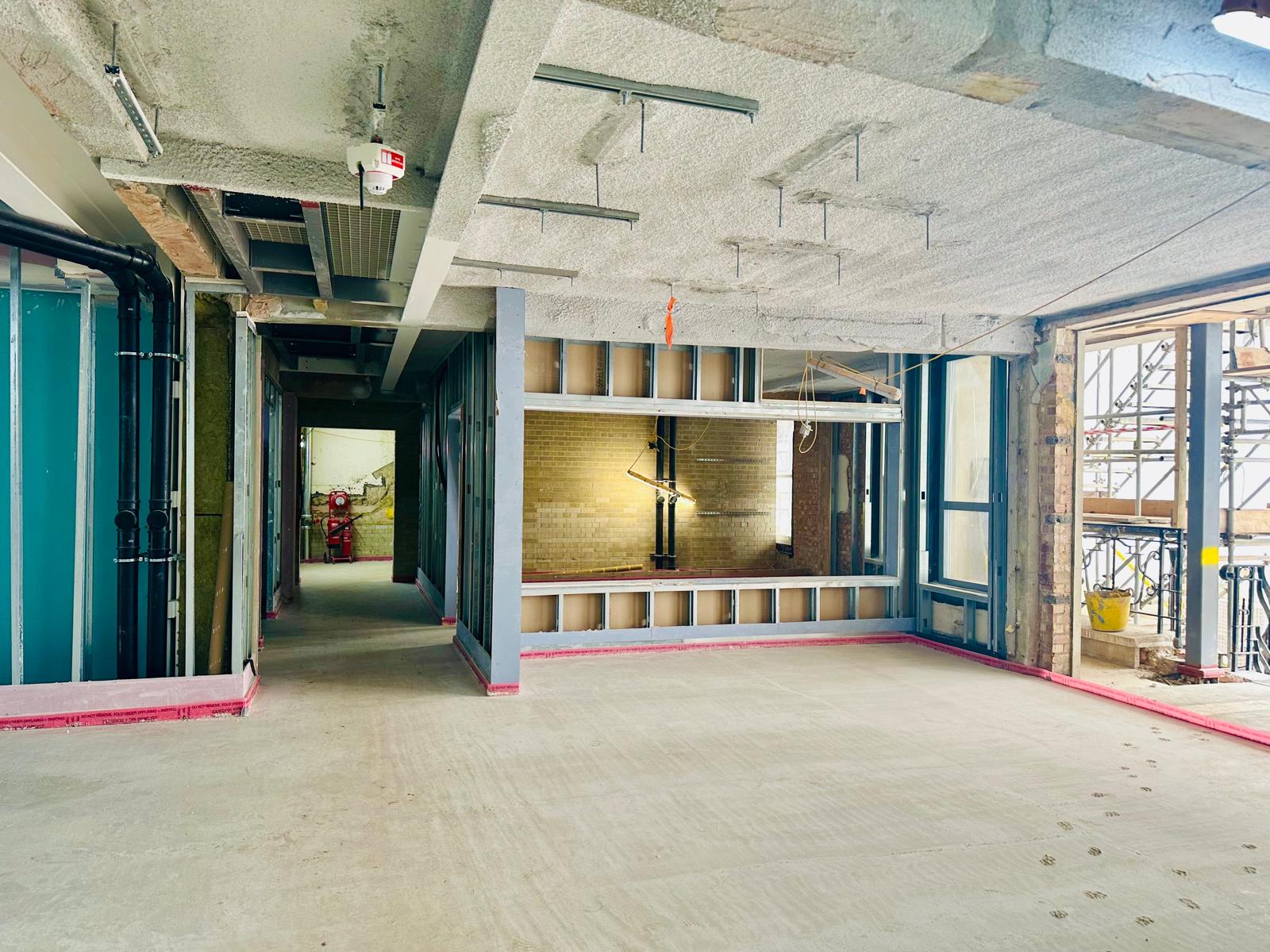

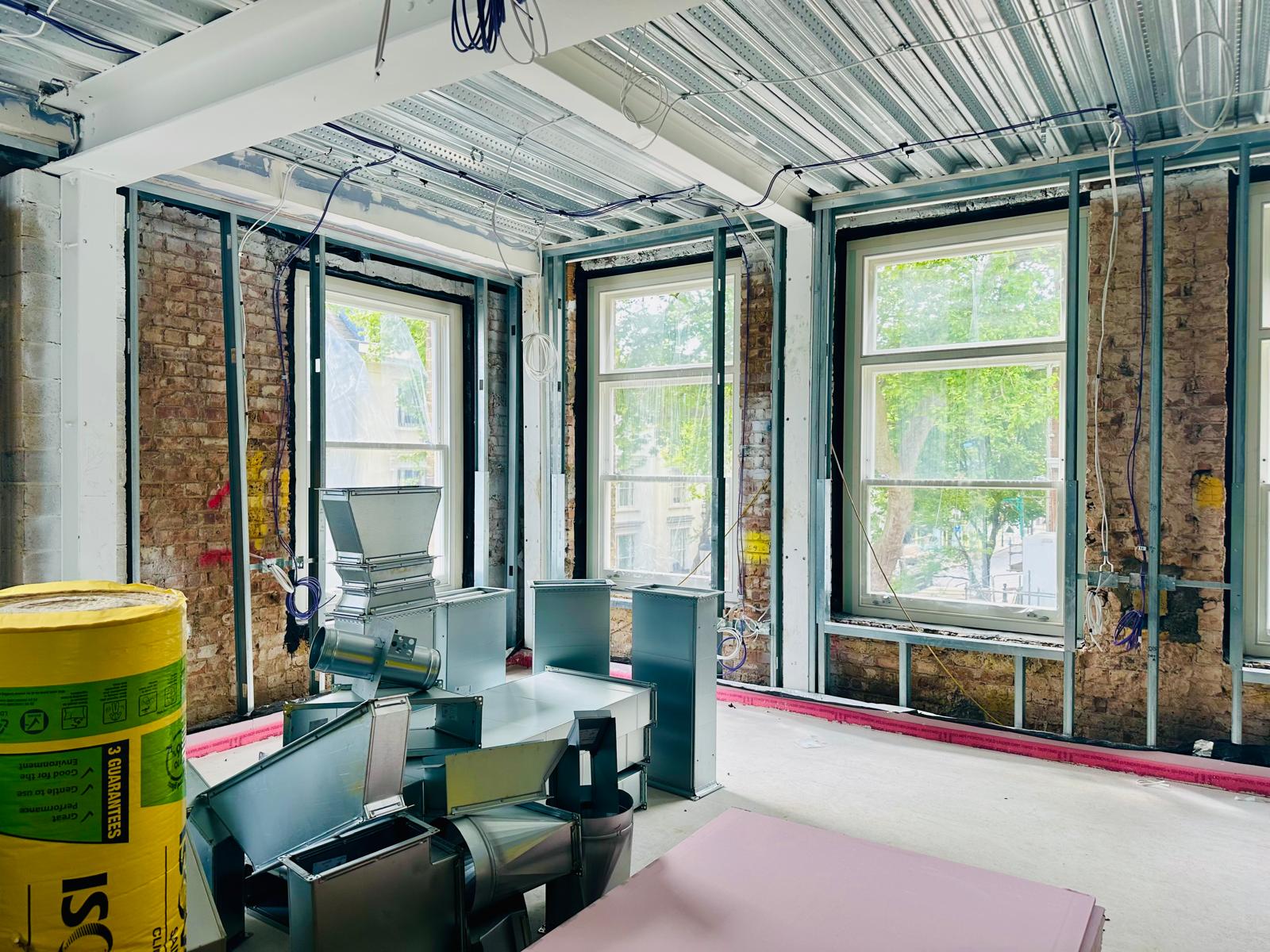

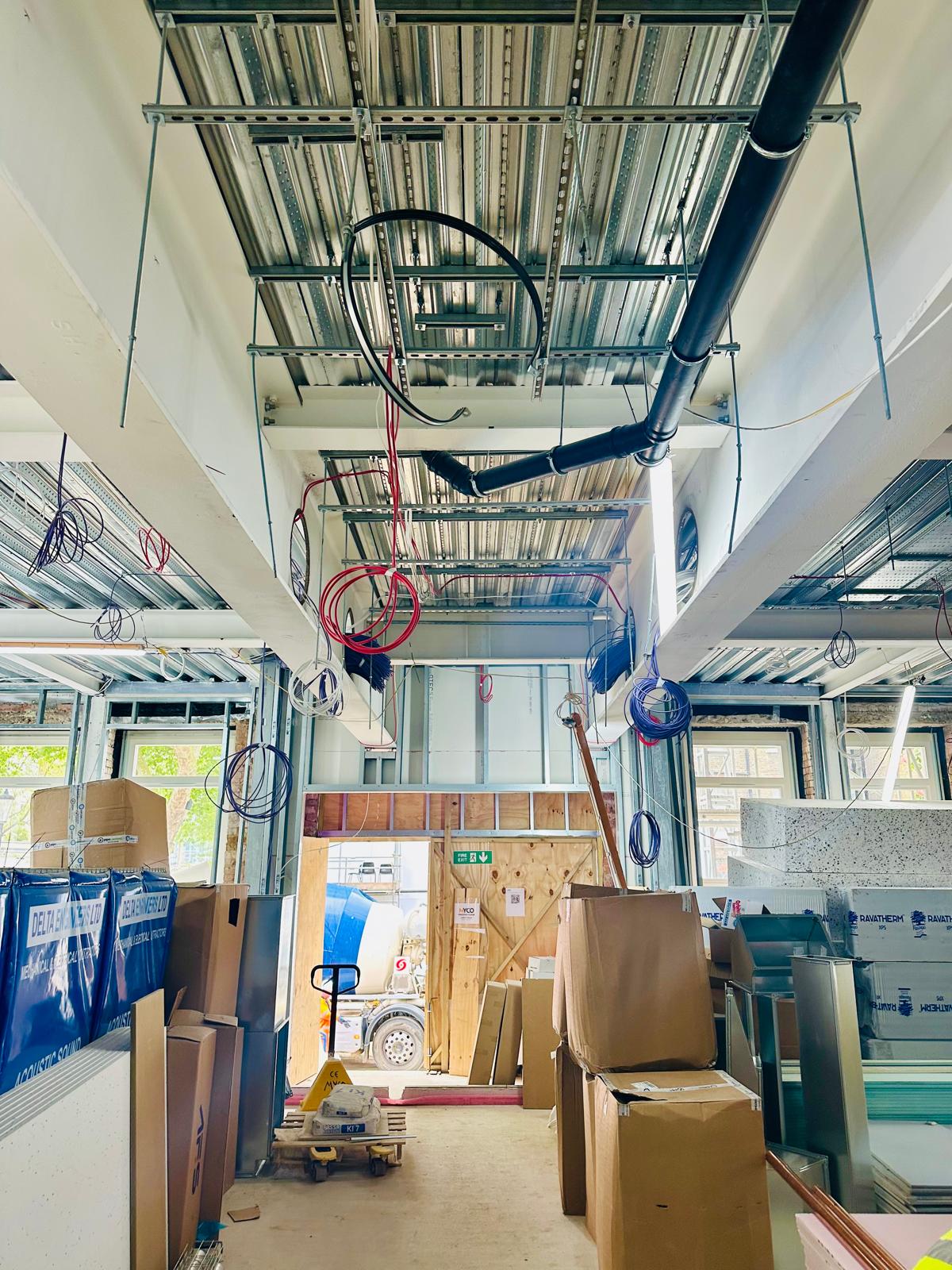

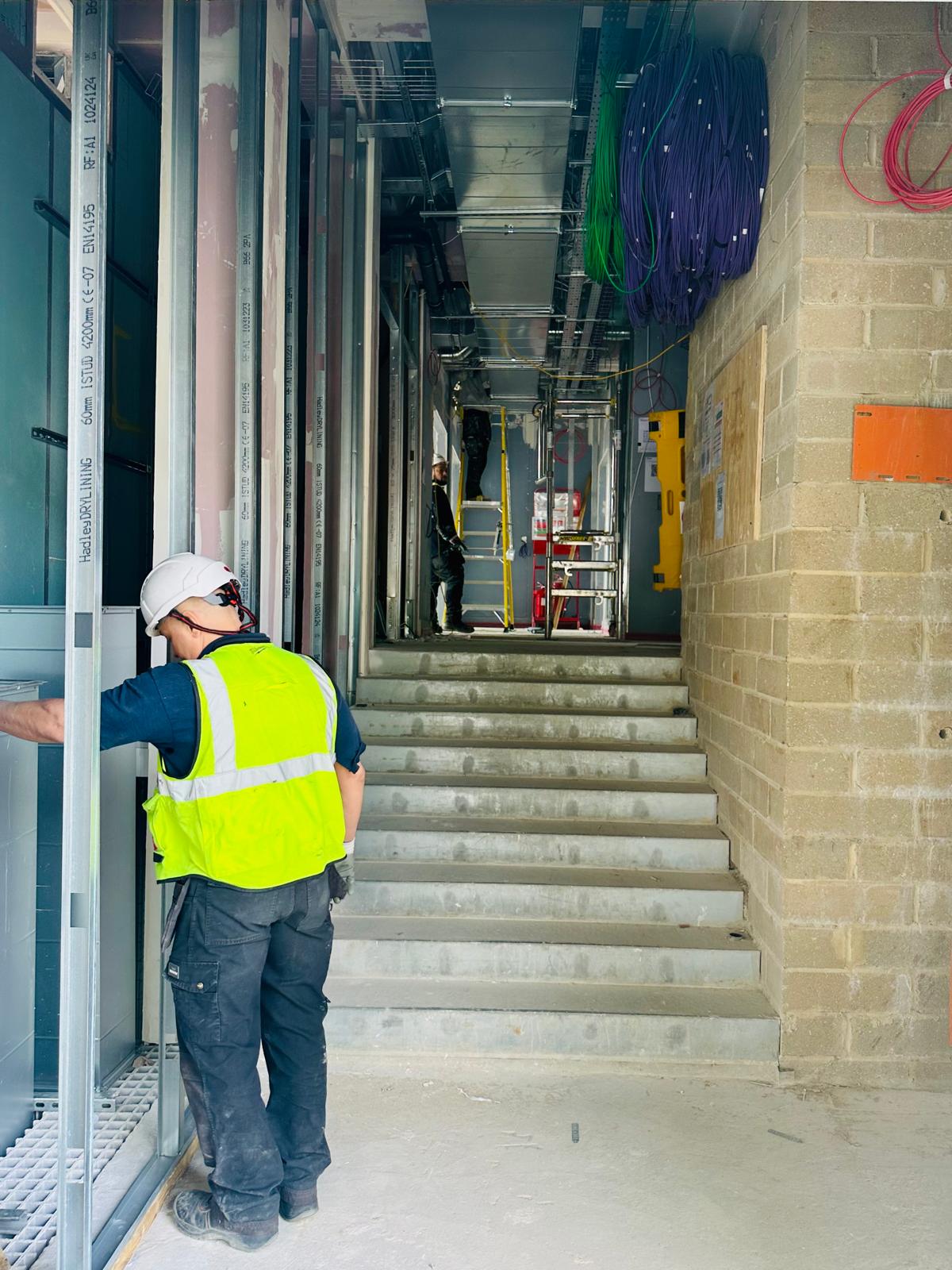

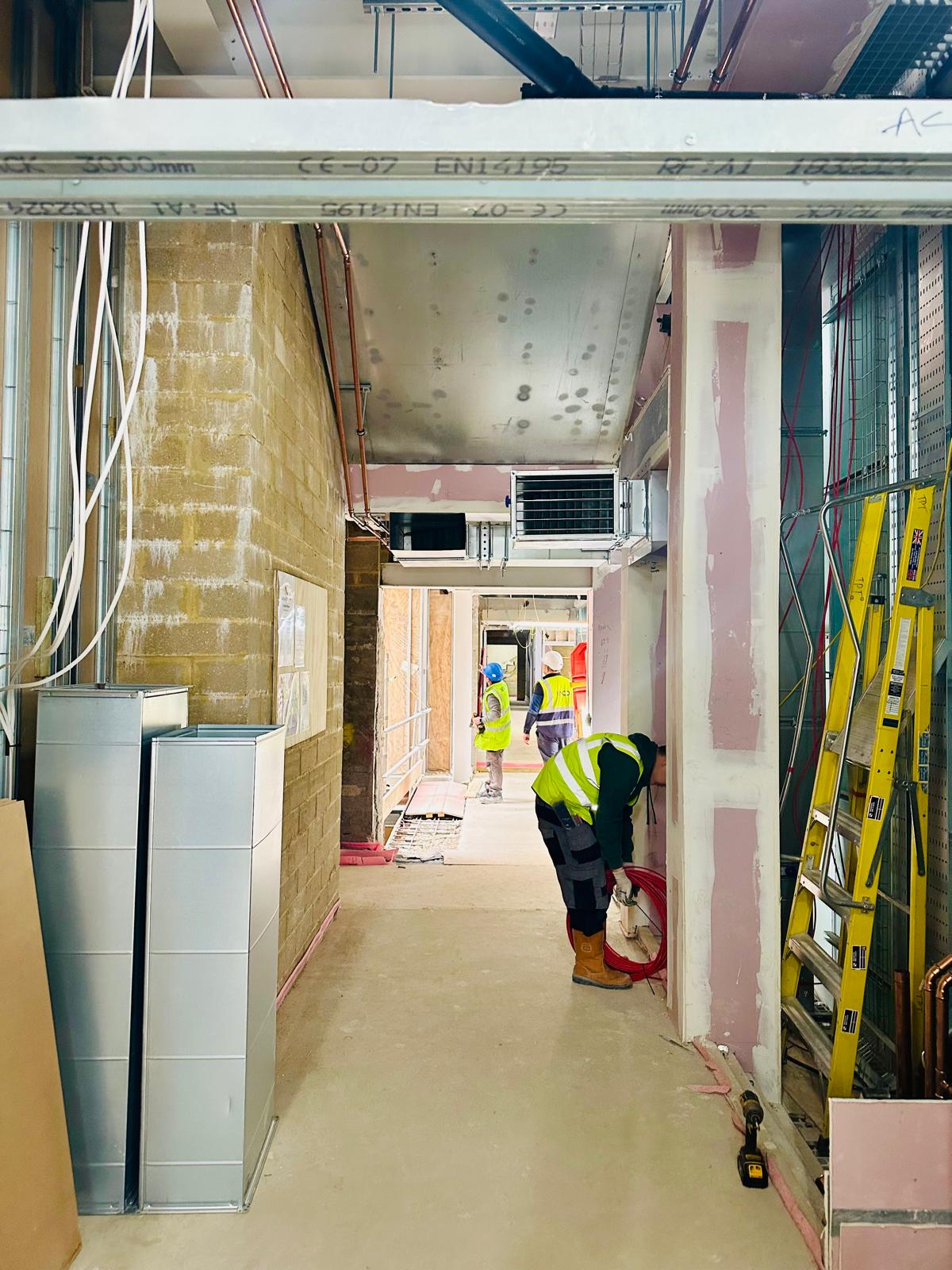

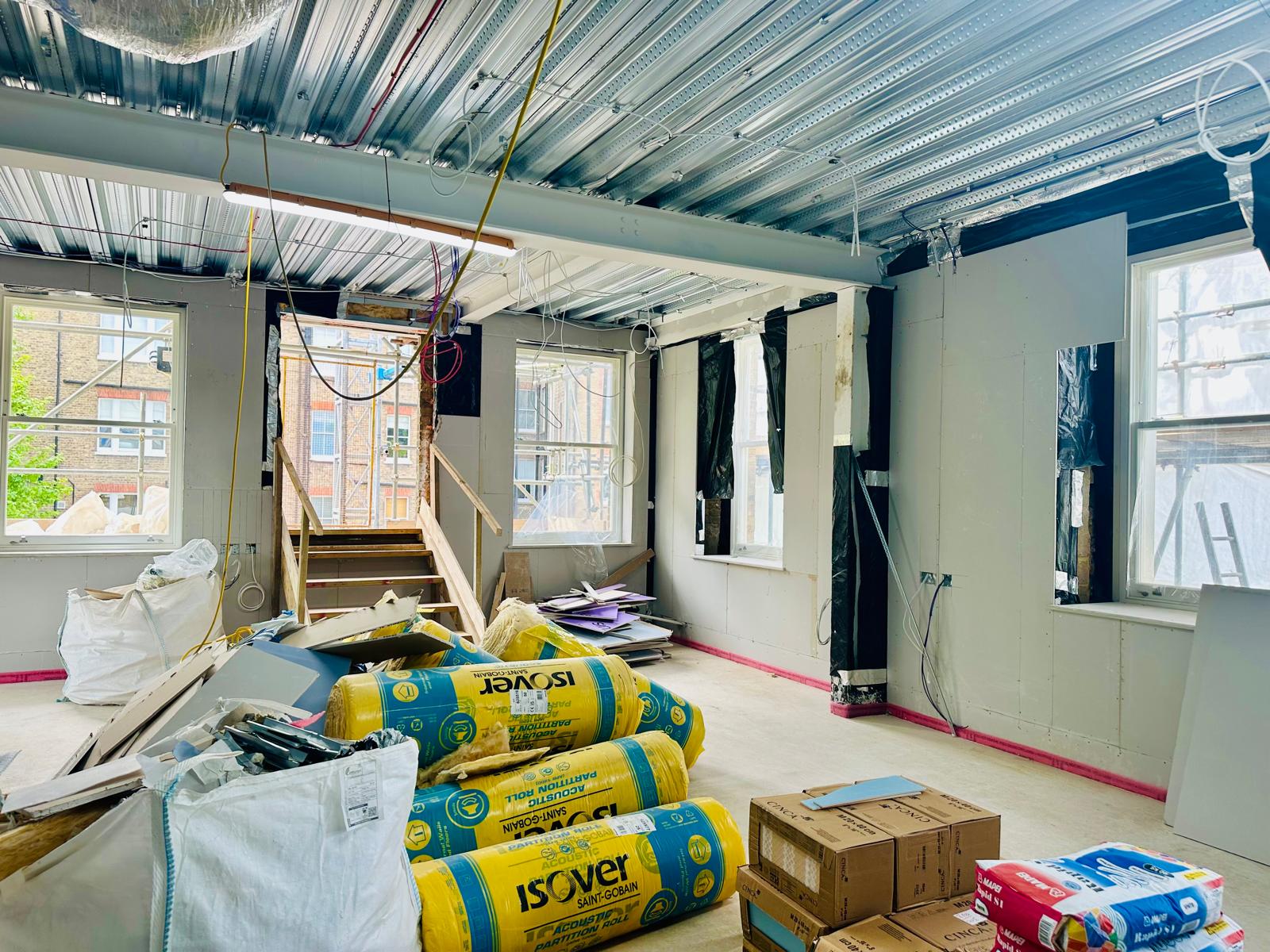

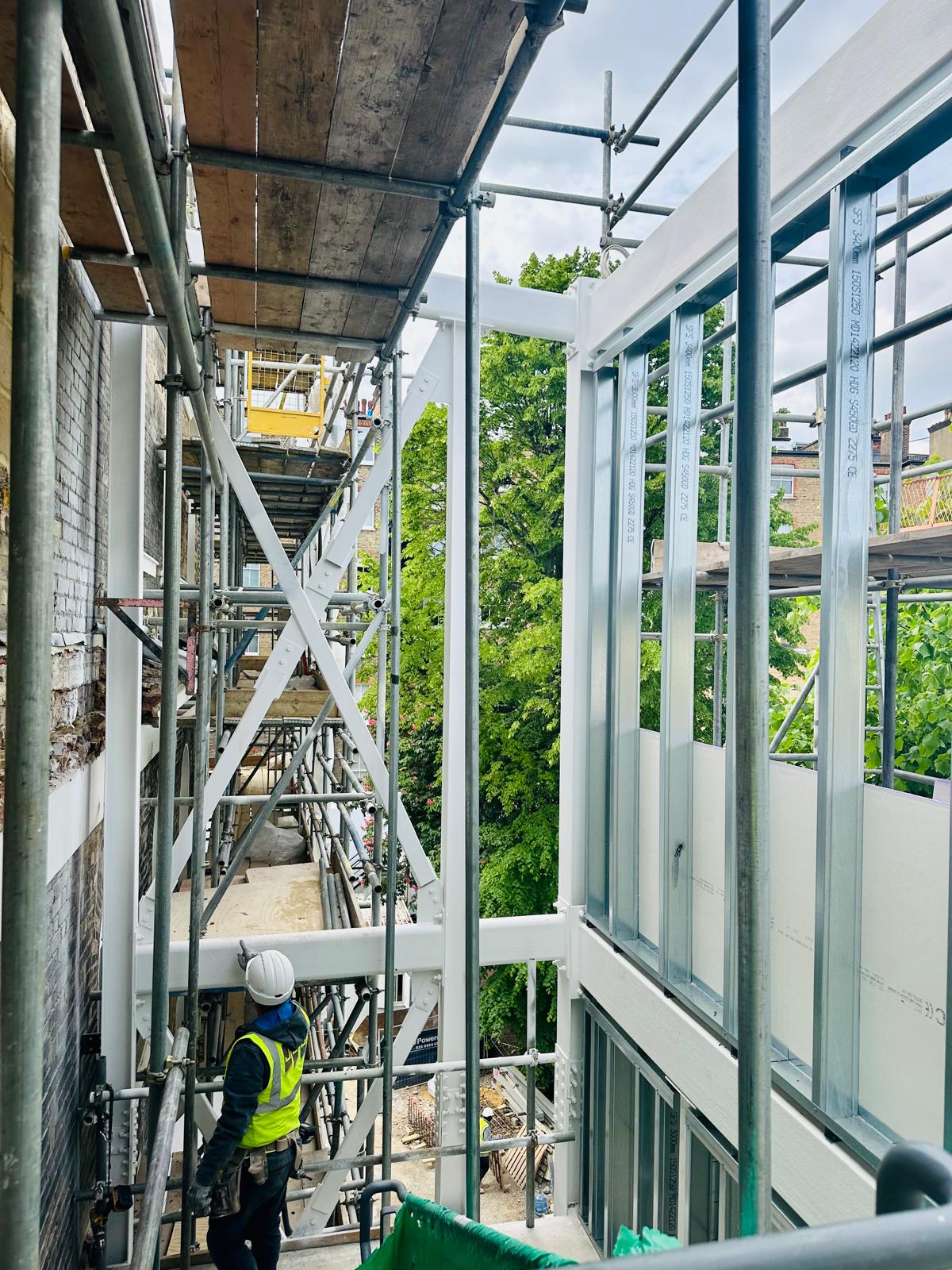

Construction Progress

July 2024

May 2024

April 2024

Operations Consultation

To view the boards that were displayed at the third round of the public consultation events (held on 12th November 2024), please use the button below.

To view the boards that were displayed at the second round of the public consultation events (held on 15th October 2024) on the proposed noise management plans for 1 St Albans Road, please use the button below.

To view the boards that were displayed at the first of the public consultation events (held on 24th September 2024) on the proposed traffic management plans for 1 St Albans Road, please use the button below.

We appreciate you taking the time to visit our community hub and viewing the consultations boards. We would be grateful if you could complete this feedback form.

Contact Us

You can contact us via the feedback function below, in addition to being able to send us an email, speaking with one of our team over the phone, or by posting a letter.

If you require a response please leave your email address.

We look forward to hearing from you.

Consultation on Amendments

Welcome

Since the application to consolidate Thomas’s Kensington at 1 St Albans Grove was approved, some required scheme amendments have been identified. These include:

  • The provision of a life safety plant and an additional power supply.
  • The retention of access along the eastern perimeter.
  • Minor external amendments.
  • Clarification on the scope of demolition.

Summary of Changes

The required amendments, due to life safety equipment, power, structural and brief requirements, uphold or enhance the original design.

Power Supply and Life Safety Plant

Since the scheme was submitted, UK Power Networks (UKPN) has confirmed it is unable to supply power to the site. This is the result of a deficiency in local infrastructure due to other schemes using all the available local power capacity in the area, which falls within the wider power supply crisis in West London. See details below.

Therefore, detailed discussions have been held with UKPN and a specialist energy company to investigate alternatives, including connecting to existing substations further away. Unfortunately, they have confirmed that there are no supplies available from the network in the area, and UKPN is insisting that a new substation is required on this site to support the project and to help backfill the wider lack of capacity in the network. UKPN is also unable to provide a secondary connection for a backup supply, which is now required under new fire regulations.

As such, the design team have had to search for a new location on the site to locate new power and life safety equipment. An extensive study has been undertaken of multiple locations, and several options have been identified as possible locations. These have been discussed with the council during the pre-application process. The option preferred by RBKC is presented below.

INTEGRATED BELOW GROUND SUBSTATION, GENERATOR AND SPRINKLER SYSTEM:

Strategies to ensure the feasibility, compliance, and quality of this proposal have been mutually agreed upon in consultation with specialist advisors in mechanical and electrical engineering, utility services, arboriculture, landscape architecture, and transport planning.

The proposed below-ground substation, located at the rear of the building, will be entirely concealed. Therefore, there will be no visual impact, and it will be acoustically closed off as it will be housed in a concrete structure. The above-ground area will be landscaped.

PROPOSED RAISED GROUND FLOOR PLAN

PROPOSED BASEMENT FLOOR PLAN

TREE REPLACEMENT

As per the recommendation from our arboriculture consultants at GHA Trees, the B1 lime tree situated on the northern boundary, referred to as T13, will need to be replaced due to the planned basement construction. To compensate for this loss, two new lime trees will be planted.

At present, the existing tree, considering its size and position, requires extensive pollarding to prevent excessive growth and the consequent adverse impacts on both the proposed site and neighbouring sites. By replacing this tree, a better strategy can be put into place for maintenance to avoid the need for this procedure.

Retained Service Access

Access along the eastern perimeter will be retained and become a service route/secondary access only, removing the need for unnecessary excavation and disruption, as well as creating a quieter boundary for neighbours.

The omission of the previously proposed ramp that ran along the eastern boundary of the site, will mean the site boundary condition would be maintained. It would also limit the acoustic and structural impact upon the construction to the neighbouring property.

View of Eastern Access from St Albans Grove

Minor External Amendments

Since the submission of the previous scheme, minor external amendments have emerged during the design development process. However, the fundamental project design and principles remain unchanged. These amendments, designed to accommodate the new requirements, are considered an opportunity to deliver a higher-quality scheme that not only maintains but also enhances the original design.

The diagram below demonstrates these additional minor changes and reasoning.

ATLANTIC HOUSE & LINK BUILDING

Approved Scheme – NORTH ELEVATION

Proposed Scheme – NORTH ELEVATION

Approved Scheme – NORTH-WEST AXO

Proposed Scheme – NORTH-WEST AXO

Scope of Demolition Clarification

The amendments respond to structural requirements that have emerged during design development since the previous scheme was submitted. The overall project design and principles remain unchanged.

The amendments to address these new requirements have been considered as an opportunity to deliver a higher-quality and equally (if not improved) sustainable scheme that upholds and improves on the original design.

STRATEGY BENEFITS

The small clarification to the extent of demolition will benefit the scheme in the following ways:

PLANNING APPROVED STRATEGY
The majority of internal structure is to be removed in Lytham House; some internal structure is to be retained in Atlantic House.

REVISED STRATEGY
The internal structure retained in Lytham House; additional internal structure is to be retained in Atlantic House South; demolition of Atlantic House North.

Approved Application

Thomas’s London Day Schools’ planning application to consolidate and rehome Thomas’s Kensington Lower and Preparatory Schools from 17-19 Cottesmore Gardens and 39–41 Victoria Road into Atlantic House, 1 St Albans Grove, received permission to grant in January 2023.

The plans set out to ensure Thomas’s Kensington provides a first-class education to local children. Further details on the associated applications can be found here; PP/22/01575PP/22/01399, and PP/22/01400.

A School for the Community

Thomas’s Kensington is a local school for local families.

This is made evident by the 85% of pupil families being RBKC residents, of these 87% live in Queen’s Gate and the immediately neighbouring wards (figures – academic year 22/23).

At least 70% of our pupils live within a 20-minute walk to the school; 40% of whom are siblings.

MYCO’s Construction Programme Overview

Key Personnel

MYCO takes a very direct hands-on approach from the Director level, the whole way through to the site delivery team. All our teams are collaborative and therefore will have had an input in all our schemes to date. We have proposed a cohesive experienced team who are committed to delivering your project on time and on budget to an exceptional quality.

EXPERIENCE
in the Construction Industry

JOHN MADIGAN

Director

+20yrs

MICHAEL MURPHY

Director

+15yrs

KEVIN CULHANE

Director

+15yrs

MYCO takes a very direct, hands-on approach from the Director level from the tender stage through to the on-site delivery and aftercare. All our teams are carefully selected for each project, and we make sure that individual skills and experience are matched to the requirements and demands of the project.

For the Atlantic House project, we have proposed a strong team who have a good synergy of working together and have collectively delivered a variety of residential schemes in challenging logistical areas of the UK and surrounding areas whilst maintaining our core values.

Bernard Mooney, our Project Manager, brings with him a wealth of experience in delivering new build projects in London and will be the main point of contact. Bernard will be responsible for the day-to-day delivery of the scheme and is an expert in maintaining strict control of programmes and will ensure both quality and safety standards are exemplary. Bernard will be supported by Mike Bragg, our Contracts Manager.

David Walsh has been selected as our senior site manager and has over 15 years of experience in the industry, delivering both new build residential and commercial projects in challenging and sensitive locations. David is a great leader with a positive can-do attitude that will ensure that the project team works as a unit to deliver a successful outcome.

Daniel Graham has extensive experience in new build and education schemes, delivering on a variety in the UK. Daniel’s skills in managing the supply chain and ensuring that the best value is sought at all stages through the design stages to delivery on site make him an asset to our project delivery teams.

Elaine Catane is our Design Manager and is responsible for controlling the design from the early stages. She has outstanding technical knowledge, and her skills are quickly showcased in design team meetings where Elaine can clearly communicate her ideas to ensure the best possible design solutions are sought. Elaine works hand-in-hand with Bernard and Daniel to ensure that subcontractors are procured with the correct scope of works and carefully analyses all the critical interfaces to maintain our high-quality standards.

Team Structure

Overview

Despite the challenges and risks associated with any construction work, our professional team has estimated that the delivery of Thomas’s Kensington is deemed as a ‘fairly’ straightforward construction project. The overall construction programme is scheduled to last 87 weeks, starting on July 31, 2023.

Commitment to Project Delivery

We recognise the key safety concerns for this project and will mitigate them by employing only the highest standards of modern working methods and practices. Our site team is trained and experienced in managing risks at every critical interface. The neighbouring public will always be our number one priority. We will employ project-specific safety practices highlighted in our risk register, monitoring, and reviewing them daily to ensure the protection of these high-priority assets and everyone working on the project. Communication will be key to delivering a safe and successful outcome for all involved. At MYCO, we pride ourselves on effectively managing communication channels, engaging all stakeholders, and promoting collaborative work. We ensure that key project milestones are achieved with minimal disruption for everyone. We are a proactive and forward-thinking contractor who creates bespoke social values and sustainable plans for the local community on each of our projects. We believe in partnering with local stakeholders early on to manage expectations regarding the impact this project will have on local businesses and companies.

Sensitive Stakeholder Management

We are a member of the Considerate Constructors’ Scheme and set a score of 40 or above as the minimum standard for all our projects. With this project, as with others, we will ensure that our core values are embedded in everyone working on it. Our commitment to working with local communities to promote and improve the construction industry will be promoted at every opportunity, whether it be through offering work experience placements, assemblies in local schools, or guided tours of a live construction site.

A First-Class Project Team

In developing our construction methodology and logistics approach, we have gathered the best practices in successfully delivering similar schemes while keeping your vision and key drivers for time, quality, and value at the heart of our approach. At MYCO, we believe that the most successful projects are born with the pre-construction team forming the core of the on-site delivery team during the construction phase. For this reason, we have carefully selected the team to maximise outcomes in quality, cost, programme, social value, and sustainability. Harnessing over 60 years of experience in the industry, the on-site team has successfully delivered more than £200m of residential, commercial, hospitality, and leisure schemes.

Risk Management

Early identification of risks and mitigation measures ensures that we safeguard cost and programme. We allocate the risks and mitigation measures to those who are best placed to manage and close them out. Regular risk management workshops throughout the early works and construction ensure effective management. We have partnered with MadiganGill Logistics on many of our larger projects because they have a proven track record of managing and delivering in challenging logistical areas. We have developed logistics plans alongside MadiganGill with site surveys for Atlantic House. They utilise an electronic delivery management system (EDMS) that all suppliers and subcontractors will use to ensure coordinated deliveries.

Mobilisation and Site Setup

The enabling works (preparation of a site in readiness for the first stage of development) are due to start on Monday, July 31. This first stage of the project is scheduled to last 7 weeks, during which we will erect a new hoarding line, and the site compound will be established. The hoarding will be further adapted to accommodate the needs of each phase of the construction process. We will clear the site of any debris left over by the enabling works contractor and proceed to establish our site offices and welfare facilities. Following site setup, a demolition scaffold will be set up around the building, a roll-on/roll-off 20-yard skip will be placed in the compound, and the soft strip will commence with rubbish going directly into the skip via a rubbish chute. After the soft strip, a Brokk machine will be lifted onto the roof, and the hard demolition will commence from the roof to the ground floor slab. As the building is demolished, our scaffold contractor will remove the demolition scaffold in sequence down to the ground floor. While the main demolition is ongoing, our temporary works will be installed between the two buildings. We have met with our temporary works engineer on-site and have produced an initial Temporary Works markup.

Surveys and Investigations

Upon taking possession of the site setup, a full site survey will be conducted to confirm the site levels, boundaries, and plot positioning. We will carry out due diligence checks, including surveying the active and inactive utilities on-site, to confirm that all the existing services have been disconnected by the demolition contractor, except for a water main that will be used for the temporary builder’s services.

Structural Demolition

The structural demolition is planned to start on September 18, 2023. Most of the demolition will be done by hand or by mechanical means using a Brokk machine. An excavator will load the rubble onto 8-wheeler lorries, which will then be taken from the site. Substructure works will also commence once the basement slab of Lytham House is removed, including the installation of foundations and drainage.

Temporary Support, Groundworks, and Sub-Structure

Excavation and groundworks are planned to start in October 2023. Prior to the structural alterations in Lytham House, temporary works are required to support the structure. The works will be followed by underpinning and the construction of the pile mat for the reduced levels in Lytham House. The installation of temporary works to the new load-bearing steelwork will continue up through the floors of Atlantic House. Once the steel has been installed and dry packing is complete, our demolition contractor will return to complete the demolition.

Superstructure and Steel Frame

The superstructure and steel frame are planned to start in November 2023. Following the demolition works related to Lytham House, our steel erectors will install the new steel frame. Once the steel frame has been lined and levelled, our carpenter will install the ‘posi’ joists to form the new floors. At the same time, a scaffold will be installed around the perimeter.

Envelope

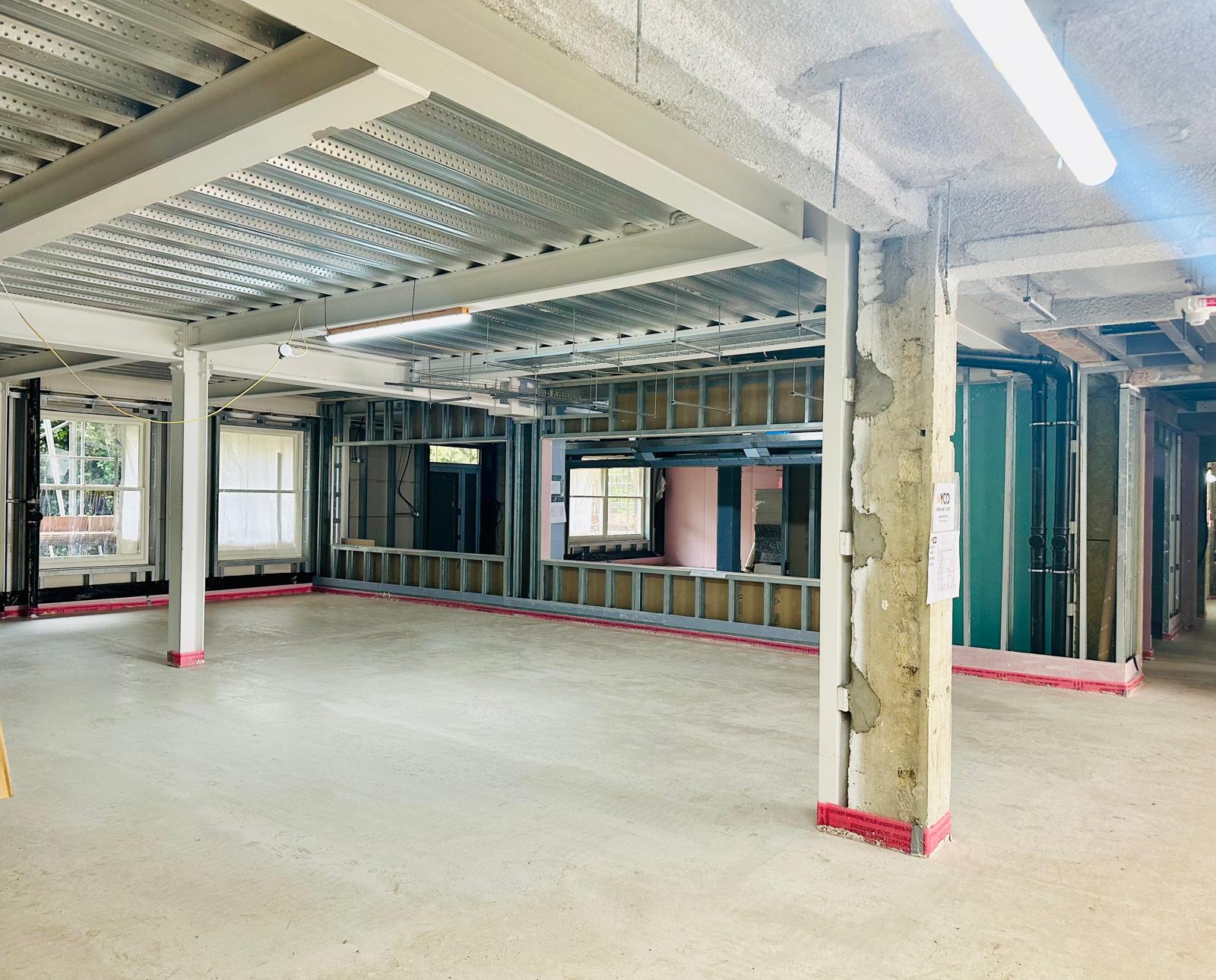

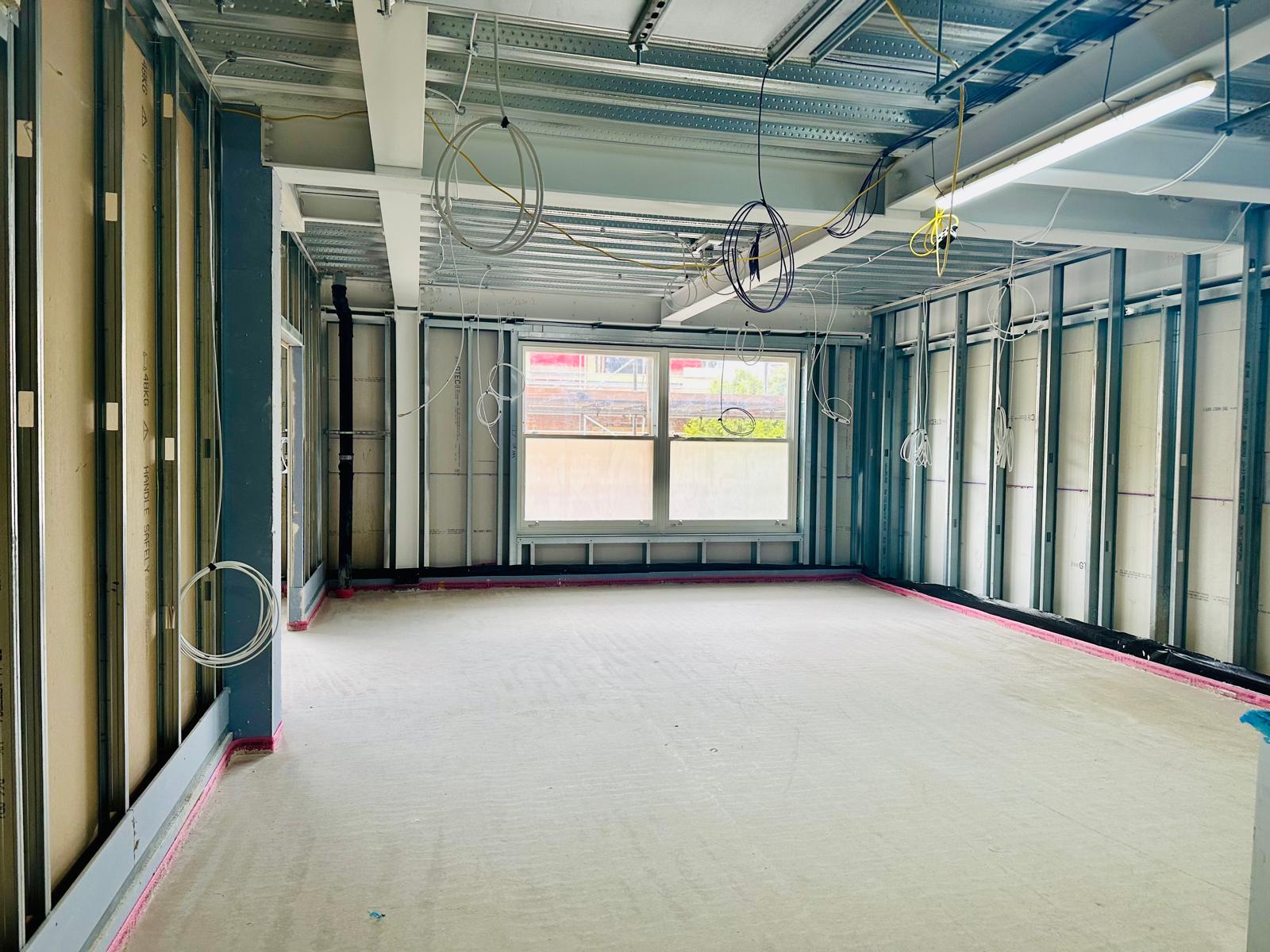

The envelope work is planned to start in October 2023. The envelope will primarily consist of curtain wall and brick construction, facing an insulated SFS inner wall. Upon completion of the facade and roof works, the scaffolding will be dismantled to allow hand and soft landscaping to commence.

Tree Protection During Construction

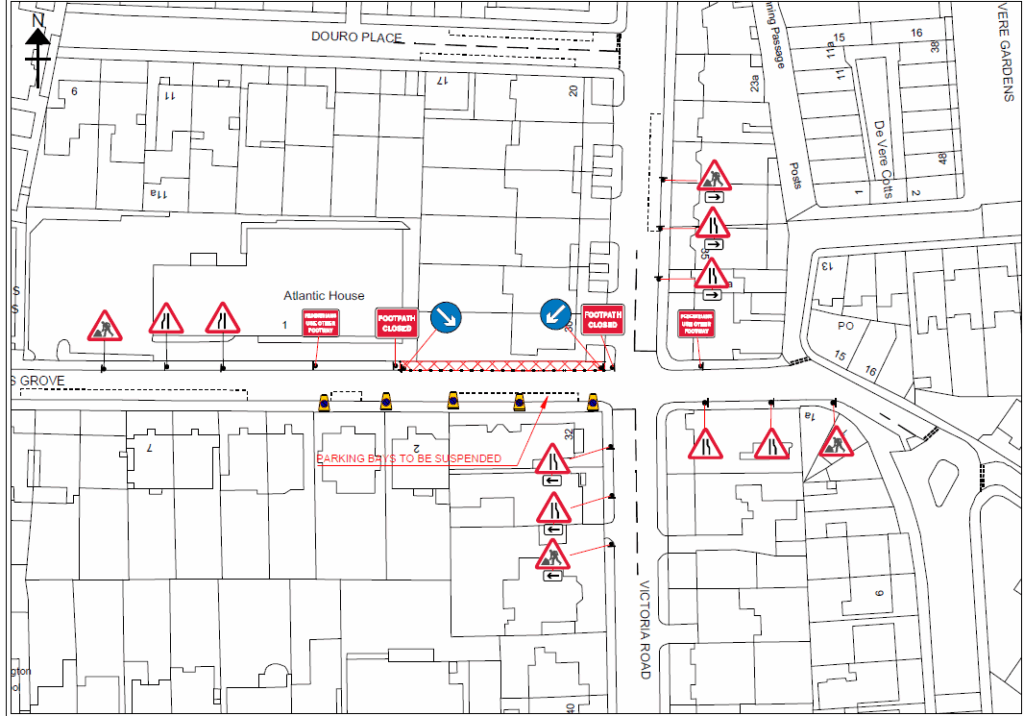

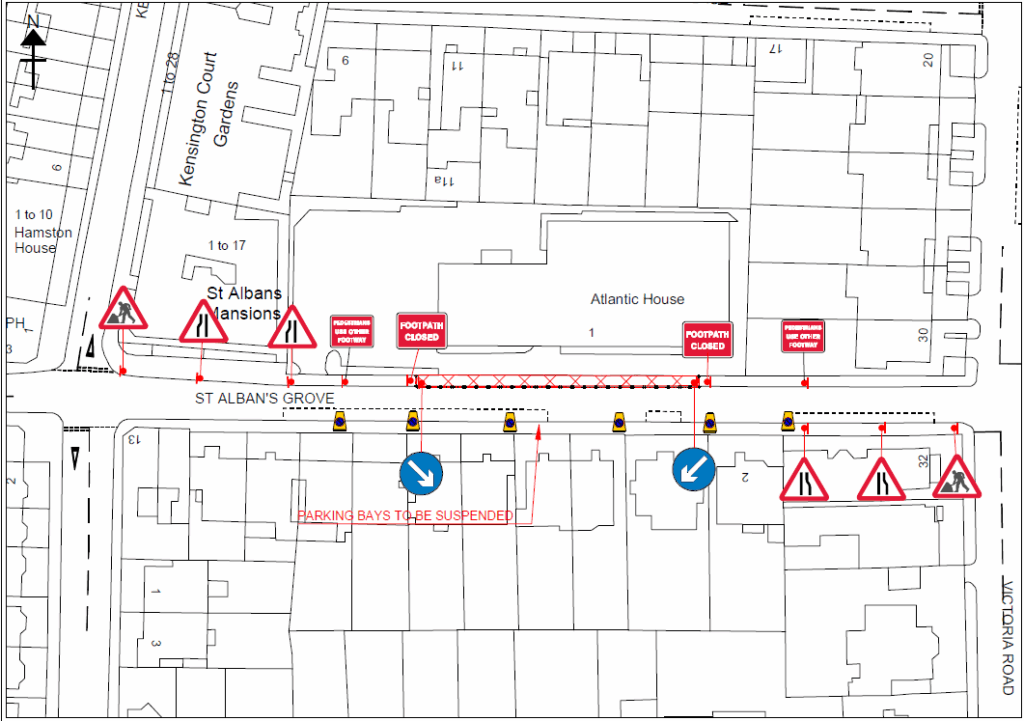

The Root Protection Area (RPA) indicates the minimum area around a tree deemed to contain sufficient roots and rooting volume to maintain the tree’s viability, and where the protection of the roots and soil structure is treated as a priority. The default position is for the RPAs to be fully fenced off to form the boundary of the Construction Exclusion Zone (CEZ), an area based on the RPA, from which access is prohibited for the duration of the project, including the storage of any works materials and equipment.

A Tree Protection Barrier (TPB) comprising 2 metre-tall, welded mesh panels (‘Heras’) shall be erected to protect retained trees. The fence panels shall be joined together using a minimum of two anti-tamper couplers, installed so that they can only be removed from inside the fence. The distance between the fence couplers should be at least 1 metre and should be unfirm throughout. The panels should be supported on the inner side by stabiliser struts, which should normally be attached to a base plate secured with ground pins (figure a). Where the fencing is to be erected on retained hard surfacing or it is otherwise unfeasible to use ground pins, e.g., due to the presence of underground services, the stabiliser struts should be mounted on a block tray (figure b).

Tree Protection Barrier Specification

(fig. a – top | fig. b – bottom)

The TPBs are to be erected before any work (other than tree surgery) commences on site, are to remain ‘in situ’ undamaged for the duration of all work or each phase and are only to be removed once all work is completed. If any work is deemed necessary prior to the erection of fencing a Landmark Trees representative should be informed to enable their presence to oversee the work being carried out.

Supervision

On this site, a site manager will be nominated to be responsible for all arboricultural matters. A pre-commencement site briefing/meeting between the site manager and arboricultural consultant will be held. The site manager’s details will be issued to RBKC in the minutes/site monitoring report for this meeting. During this meeting, all the tree protection methods below will be studied and familiarisation with the requirements of the Arboricultural Methods Statement (AMS). The site manager will also:

  • Be presented on-site for the majority of the time.
  • Have the authority to stop any work that is causing or has the potential to cause harm to any tree.
  • Be responsible for ensuring that all site operatives are aware of their responsibilities towards trees on site and the consequences of the failure to observe these responsibilities.
  • Make immediate contact with the arboricultural consultant in the event any tree-related problems occur whether actual or potential, in accordance with a tree protection protocol.

In addition, general monitoring of protection measures will be undertaken at least once per month. More information regarding supervision can be found in the full AMS document.
